How to Read a C&I BESS Warranty Before You Buy

A C&I BESS warranty is not just a number of years. It is a contract that guarantees performance only inside a defined operating envelope.

That envelope covers capacity, throughput, depth of discharge, C-rate, and temperature. However, operating outside a stated limit may reduce coverage or affect a claim, depending on the contract terms and the documented cause of the issue.

First, this guide shows how to read each term before you sign. It also ties the warranty back to your peak-shaving BESS sizing, so the system can still meet your kW and kWh needs late in life.

⚡ Quick Answer: A C&I BESS warranty is more than a number of years. It is a set of performance promises that apply only within defined operating limits. So check guaranteed capacity, throughput, depth of discharge, C-rate, temperature, test method, exclusions, and the remedy before you compare suppliers.

What a C&I BESS Warranty Actually Covers

A C&I BESS warranty usually bundles several separate promises. Scope, duration, and exclusions vary by supplier and contract, so read each promise on its own.

  • Product or defect warranty: covers faulty parts and manufacturing defects.
  • Capacity-retention warranty: guarantees a minimum state of health (SoH) at set points in time.
  • Throughput or cycle-life warranty: limits the total energy or cycles the system may process.
  • Performance warranty: may add an efficiency commitment, depending on the contract.
  • Workmanship warranty: covers installation quality when SunLith or an EPC provider supplies it.
  • Subsystem coverage: identifies whether the PCS, EMS, BMS, HVAC, enclosure systems, and any supplied fire-detection or suppression equipment are covered, and for how long.

Also, each item can carry its own term, limits, and remedy. For example, a long cell warranty does not prove the PCS or cooling system is covered for as long.

C&I BESS Warranty Terms: Capacity Retention vs. Throughput

SunLith Energy  Line chart concept showing guaranteed C&I BESS warranty capacity retention declining to an end-of-life floor over ten years

Most disputes over a C&I BESS warranty start with two terms. But capacity retention and throughput control very different things.

TermWhat it controlsBuyer question
Capacity retention / SoHRemaining usable energy at a specified point in timeAt what measurement boundary and operating conditions is capacity tested?
ThroughputTotal permitted energy processed during the warrantyIs throughput counted one way, both ways, or as equivalent full cycles?
Equivalent full cyclesAn accounting measure of throughput relative to capacityWhat capacity denominator and counting method does the contract use?
End-of-life thresholdThe contractual capacity floor at a stated year or throughput valueDoes that floor still satisfy the project’s service obligation?

Capacity Retention and State of Health

Capacity retention sets the minimum usable energy at a stated point in time. For example, a contract might guarantee 70% of baseline capacity at year 10 (illustration only).

First, the key issue is the measurement boundary. Capacity can be quoted at the cell, the DC bus, the PCS AC output, or the point of interconnection.

Because of this, each boundary gives a different number. Also confirm the beginning-of-life baseline, because a retention percentage means little without it.

Throughput and Equivalent Full Cycles

A throughput provision may limit the cumulative energy processed during the warranty. For example, some contracts count discharge only, while others count charge and discharge together.

Then equivalent full cycles convert that energy into a cycle count. The result depends on the capacity used as the denominator, so ask for the exact formula.

An open-access review in Energies discusses degradation models based on cumulative energy throughput. It also covers models that account for cycling conditions such as depth of discharge, state of charge, and temperature.

But contracts often use the simpler count. Your dispatch pattern still decides how fast the cells age, so learn how equivalent full cycles and throughput records are tracked in the BMS.

End-of-Life Thresholds

An end-of-life threshold is the contractual capacity floor a supplier agrees to support, subject to the stated terms. It applies at the year or throughput value that the contract names.

Then check that this floor still meets your service obligation. As a result, a battery can meet its warranty floor and still miss your load requirement.

Capacity fades on two clocks, time and use. See calendar and cycle aging for how each one works.

In addition, see SunLith’s battery degradation in BESS guide for the mechanisms and mitigation options behind capacity loss.

The Operating Envelope Behind Every C&I BESS Warranty

Every C&I BESS warranty rests on assumed operating conditions. As a result, if the site operates outside those conditions, coverage may be limited or a claim may be disputed under the contract.

A warranty can be technically valid but commercially unsuitable if the operating limits do not match the intended dispatch plan.

Charge, Discharge, and Depth Limits

First, list every electrical limit the contract sets. Typical items include:

  • Maximum and minimum state of charge
  • Permitted depth of discharge
  • Charge and discharge C-rate

Throughput terms often carry a maximum C-rate clause as well. Then compare your peak discharge power against the BESS C-rate limit in the contract.

Time, Temperature, and Throughput Limits

Next, check the limits tied to time and environment:

  • Temperature and humidity requirements
  • Calendar limits versus cycling limits
  • Annual or cumulative throughput limits

For example, many contracts specify that coverage ends when the first applicable limit is reached. So look for the phrase “whichever occurs first.”

Controls, Data, and Maintenance Duties

Finally, review what the owner must do to keep coverage intact:

  • Follow the approved EMS settings and dispatch behavior
  • Complete the required maintenance
  • Keep connectivity, monitoring, and event logging active

However, missing data can make a claim hard to win. Our guide to evaluating a supplier’s BMS also explains SOH and throughput logging.

Why C&I BESS Warranty Terms Affect Peak-Shaving Design

Sizing sets your first kW and kWh requirement. The C&I BESS warranty then decides whether the system can keep meeting it.

Take the 100 kW / 278 kWh preliminary configuration in the peak-shaving guide. It illustrates how first-year power and energy requirements can be estimated for one defined peak event.

However, whether it can meet repeated events or retain enough capacity late in life depends on the operating plan and the warranty’s limits.

Next, here is a simple, hypothetical check. If a contract permits 3,000 equivalent full cycles, and the site uses one equivalent full cycle on each day it operates, daily cycling would reach that limit in about 8.2 years (3,000 ÷ 365).

But if the system uses one equivalent full cycle on only 150 days each year, it would take about 20 years to reach the same limit. Calendar limits may then determine when coverage ends.

Also, an equivalent full cycle is an energy measure, not a single dispatch event. These figures are illustrations, not market terms.

So check size and dispatch strategy against the warranted envelope, not just first-year savings. Warranty terms also feed your BESS OPEX and CAPEX vs LCOS assumptions, because lost throughput raises the cost of each delivered kWh.

C&I BESS Warranty Checklist for RFQs

First, use this C&I BESS warranty checklist in every request for quotation. Ask each supplier the same questions so the answers compare cleanly.

Capacity and Baseline Questions

  1. Is capacity measured as nameplate, usable DC, PCS AC, or energy at the point of interconnection?
  2. Which beginning-of-life capacity baseline applies?
  3. How much retained capacity is guaranteed at each year or throughput checkpoint?
  4. Which testing method verifies capacity, and under what site conditions?

Throughput and Operating Limit Questions

  1. Is there a calendar limit, cycle limit, throughput limit, or a “whichever occurs first” condition?
  2. How is throughput counted: charging, discharging, both directions, or equivalent full cycles?
  3. What DoD, C-rate, temperature, SOC range, and dispatch pattern does the warranty assume?
  4. How is an equivalent full cycle calculated and logged?

Scope, Exclusion, and Remedy Questions

  1. Which components are included: cells, modules, racks, BMS, PCS, HVAC, EMS, enclosure systems, and any supplied fire-detection or suppression equipment?
  2. Which exclusions can reduce or invalidate coverage?
  3. What data must the owner retain to support a claim?
  4. If the system misses a warranted value, what is the remedy: repair, replacement, payment, capacity augmentation, or another remedy? Who pays for labor, logistics, downtime, testing, and recommissioning?

Also, pair this list with our guide on how to compare BESS specifications for datasheet items.

Since the remedy may be added capacity, plan that work early. Our guide to BESS augmentation planning explains how lost capacity is restored.

Common Mistakes When Comparing Warranty Bids

Buyers often repeat the same errors when they compare bids. Next, avoid these five:

  • Comparing years alone: two bids with equal terms can carry very different limits.
  • Ignoring the measurement boundary: a DC figure and an AC figure are not the same promise.
  • Assuming equal throughput counting: one bid may count discharge only, another both directions.
  • Skipping the dispatch check: the warranty may not fit your real duty cycle.
  • Accepting a vague remedy: insist on clear timing, cost, and responsibility.

Frequently Asked Questions About a C&I BESS Warranty

These answers cover the questions buyers ask most about a C&I BESS warranty.

What does a C&I BESS warranty cover?

It usually covers defects, a capacity or state-of-health guarantee, and sometimes a throughput limit. Also, scope and duration vary by supplier and contract.

How do capacity retention and throughput differ?

Capacity retention sets a minimum usable energy at a point in time. Meanwhile, throughput caps the total energy the system may process during the warranty.

Can a C&I BESS warranty be valid but still unsuitable?

Yes, because if its limits on depth, C-rate, or throughput do not match your dispatch plan, the system can reach a contract limit early.

What is a BESS performance warranty?

A BESS performance warranty defines measurable commitments, such as usable capacity, capacity retention, energy throughput, availability, or efficiency, under specified test conditions and operating limits. The exact scope and remedy depend on the contract.

What is end of life in a BESS warranty?

It is the contractual capacity floor at a stated year or throughput value. Then confirm that it still covers your required kWh.

Who should review a BESS warranty before signing?

Your engineer, procurement lead, and legal counsel should each review it. SunLith can provide a preliminary specification review, but contract terms need qualified legal review.

Need a Preliminary Warranty Review?

Send us your datasheet and draft warranty terms. Then we will flag the limits that matter for your dispatch plan.

Request a preliminary BESS specification and warranty review

SunLith can provide a preliminary assessment. Final system design and contract terms require site-specific electrical, tariff, interconnection, safety, and legal review.

Further Reading on the C&I BESS Warranty and Related Costs

Also, use these guides alongside this C&I BESS warranty guide.

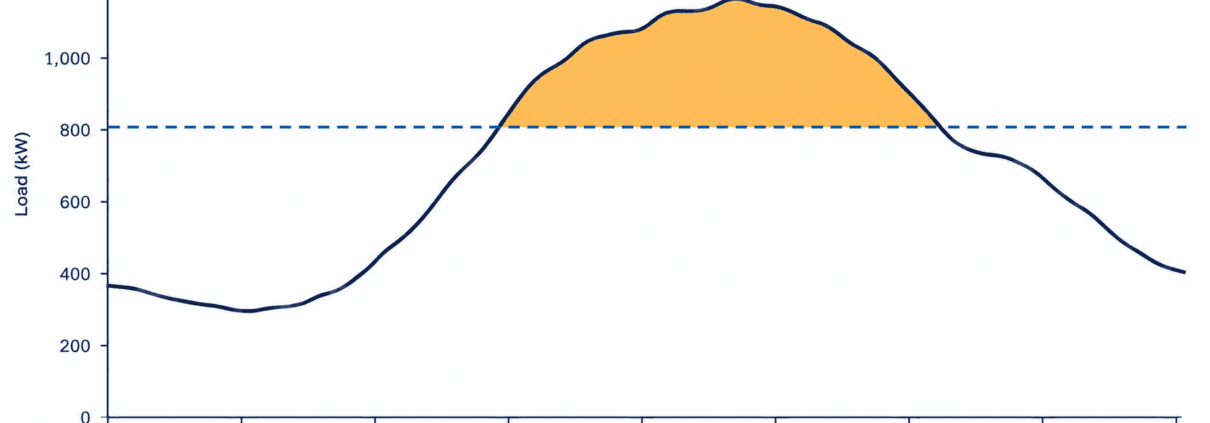

SunLith Energy Peak shaving battery sizing chart showing site load against a grid-demand target

Peak Shaving Battery Sizing: kW and kWh Guide

Peak shaving battery sizing starts with two questions. How much power must the battery discharge? For how long? First, choose the maximum grid demand you want your facility to draw. Then analyze your interval load data. The highest load above that target sets the discharge power, in kW. The area above the target sets the delivered energy, in kWh.

Quick Answer

Peak-shaving battery sizing starts by subtracting the selected grid-demand target from site load in each interval. The highest result is the preliminary battery discharge-power requirement in kW. Add the interval discharge energy to estimate delivered kWh, then adjust for defined discharge efficiency and permitted usable capacity.

Those two numbers are only a starting point, though. A workable design must also account for discharge losses and the battery’s allowed operating range. It also needs to handle repeated peaks, charging opportunities, and how your utility calculates billed demand. Peak shaving means discharging a battery to cut peak grid demand. That is different from shifting energy use to another time, or sizing a battery for outage backup.

For a broader explanation of BESS components, operation, and applications, see SunLith’s Battery Energy Storage System (BESS) guide.

The Peak Shaving Battery Sizing Formulas at a Glance

Peak shaving battery sizing follows four simple steps for each interval in your load data. Confirm the measurement boundary, such as battery DC terminals, PCS AC output, or site meter, before applying efficiency assumptions.

New to these units? SunLith’s Ah vs Wh battery capacity guide covers the Wh = Ah × voltage relationship behind every kWh figure below.

Key Sizing Formulas

First, find the battery discharge required, in kW. Take site load, subtract the grid-demand target, and floor the result at zero. A 700 kW load against a 600 kW target needs 100 kW of discharge. A 550 kW load against the same target needs none.

Pbattery,i = max(0, Li − T)

Next, find the largest required discharge across every interval. That becomes your preliminary AC discharge-power requirement.

Prequired = maxi(Pbattery,i)

Then find the delivered energy, in kWh. Add up, across every interval in one peak event, the discharge required multiplied by the interval length in hours.

Edelivered = Σi(Pbattery,i × Δti)

Finally, estimate nominal battery capacity. Divide delivered energy by discharge efficiency, then by the usable fraction of nominal capacity. Discharge efficiency is the assumed efficiency from the battery’s energy boundary to the AC delivery point. The usable fraction is the share of nominal capacity available for this duty. Define both terms before you apply the formula, since this is only an event-level estimate. It is not a substitute for simulating state of charge over time.

Enominal = Edelivered ÷ (ηdischarge × fusable)



Where: Pbattery,i is the required battery discharge during interval i; Li is site load; T is the selected grid-demand target; Δti is interval duration in hours; ηdischarge is defined one-way discharge-path efficiency; and fusable is the permitted usable share of nominal capacity.

Step 1: Gather Load Data and the Tariff

First, ask your utility or metering provider for interval demand data covering representative operations and seasons. You need to see the shape of each peak, not just the highest number on a bill. A 100 kW exceedance lasting 15 minutes requires far less delivered energy than the same exceedance lasting three hours.

Also collect the tariff alongside the data. Identify the demand-measurement interval. Check which periods carry demand charges. Look for other billing provisions that affect the value of reducing a peak. The target should be based on how demand is measured and billed under the applicable tariff, not a generic assumption about demand charges.

One MDPI-published study of low-voltage commercial users evaluated battery energy capacity against measured customer-load data and the resulting peak reduction over time. The principle for a single facility is the same: use interval data rather than a monthly peak alone.

If the site has solar, use net demand at the relevant meter. Also model how solar output varies during likely peak events. A sunny-day profile alone may understate the battery needed on a cloudy day.

Step 2: Choose a Grid-Demand Target

Suppose a facility’s load sometimes reaches 700 kW. You could test targets of 650 kW, 600 kW, and 550 kW. Generally, a lower target asks the battery to provide more power, more energy, or both. However, whether that extra capacity pays off depends on the tariff and the full pattern of peaks.

Do not pick the target from the single highest reading alone. A battery might shave the largest peak successfully. Then it may exhaust its usable energy during a longer, lower peak later that day.

Step 3: Calculate Required Battery Power

SunLith Energy Diagram of battery discharge power calculation for peak shaving

For each interval, subtract the target from site load. If the result is negative, set the discharge requirement to zero. The table below shows this for a 600 kW target.

Example: discharge needed to hold a 600 kW target

Site loadDischarge needed to hold 600 kW
550 kW0 kW
650 kW50 kW
700 kW100 kW

The preliminary requirement here is 100 kW of AC discharge power, measured at the point where the battery offsets meter demand. An engineer must then confirm that the chosen power conversion system and installation can sustain that output under real operating conditions.

Step 4: Calculate the Delivered Energy for Each Peak

Power tells you how fast the battery must discharge, while energy tells you how much it must deliver over the whole event.

For preliminary analysis, define a peak event as consecutive metering intervals where site demand stays above the selected grid-demand target. If demand drops below the target and the battery can begin recharging, treat the next exceedance as a separate event. Verify that the available recharge time and charging-power limit are sufficient.

Assume the facility stays at 700 kW for one hour. Then it drops to 650 kW for two hours, still against a 600 kW target. That gives 100 kW for one hour, plus 50 kW for two hours. The total is 200 kWh delivered.

So this event requires 100 kW of maximum discharge and 200 kWh of delivered AC energy. A battery rated for 100 kW but able to deliver only 100 kWh would not cover the whole event at this target.

Repeat this calculation for other days and seasons. The event with the highest instantaneous discharge sets one constraint. The event with the greatest delivered energy may set the energy-capacity requirement.

Step 5: Estimate Nominal Battery Capacity

The battery must store more energy than it ultimately delivers. Discharge is not lossless, and the full nominal capacity may not be available for the chosen operating strategy.

For illustration, assume 200 kWh of required delivered energy. Assume a 90% one-way discharge-path efficiency and an 80% permitted usable fraction of nominal capacity. Divide 200 by 0.90, then by 0.80. That gives roughly 278 kWh of nominal capacity.

That figure is only an initial estimate, not a recommended product size. First, check the vendor’s capacity definition. Then account for state-of-charge limits, expected end-of-life capacity, temperature effects, auxiliary consumption, warranty commitments, and the manufacturer’s defined AC or DC capacity boundary before choosing a product.

Accounting for Discharge Losses vs. Round-Trip Efficiency

Do not treat round-trip efficiency as one-way discharge efficiency. Round-trip efficiency includes losses across both charging and discharging. Applying it as a discharge factor, then adding separate discharge losses on top, counts losses twice. A preliminary sizing tool may use round-trip efficiency as a simplified assumption. Final peak shaving battery sizing should still call out discharge-path losses on their own.

SunLith’s guide to understanding BESS specifications explains how vendors actually define usable capacity and efficiency, both needed for this step.

Step 6: Test Repeated Peaks and Recharging

SunLith Energy Battery state of charge simulation across repeated peak shaving events

The example above assumes the battery has enough charge when the event begins. Real facilities may see several peaks a day, peaks on consecutive days, or an unusually long stretch above the target. Charging too aggressively can itself create a new metered peak.

Run the load profile forward, interval by interval, using these five steps.

  1. Begin with an assumed battery state of charge.
  2. Discharge whenever load would otherwise exceed the chosen target.
  3. Track remaining energy and all applicable losses.
  4. Allow charging only when it fits the tariff, site load, and equipment limits.
  5. Check whether the battery is ready for the next event.

This simulation may reveal that a seemingly adequate 100 kW / 278 kWh preliminary configuration needs more capacity. Or it may show that a different demand target produces a better project. Model peak-shaving dispatch and resulting bill impacts together this way, instead of inferring them from a single peak value.

Sample Interval-Data Worksheet Columns

A simple spreadsheet makes this simulation easier to run and easier to hand to an engineer. Track these six columns for every interval in the load dataset.

ColumnWhat it records
TimestampDate and interval start time
Site load (kW)Measured or forecast demand for the interval
Target (kW)The grid-demand target being tested
Discharge required (kW)Site load minus target, floored at zero
Delivered energy (kWh)Discharge required times interval hours
Simulated state of charge (%)Running battery charge after each interval

Step 7: Check Whether the Battery Size Makes Financial Sense

A technically workable target is not always the most economical one, though. Compare several combinations of battery power, energy, and target demand against the real tariff and a no-storage baseline. Include the cost of charging, equipment and installation, operating costs, and expected capacity changes over the project life.

SunLith’s peak shaving vs load shifting guide explains the two strategies and where they overlap. Use it to understand the value stream, not as an interval-based sizing tool.

For the financial modeling itself, SunLith’s guide to calculating BESS ROI walks through the cash-flow side. Use it once the power and energy numbers from this sizing exercise are in hand.

Common Peak Shaving Battery Sizing Mistakes

Because these errors repeat across projects, they turn a sound peak shaving battery sizing exercise into an undersized or overpriced one.

Using only the monthly peak: It does not show how long or how often demand exceeds your target.

Confusing kW with kWh: The maximum exceedance sets discharge power. Duration and shape set delivered energy.

Sizing from one favorable day: Solar production, weather, occupancy, and operations can all change the peak profile.

Ignoring the next event: The battery may suit one peak but fail to recharge before another.

Assuming every kWh of nameplate capacity is usable: Operating limits and performance requirements must be checked against the proposed product.

Treating demand-charge savings as guaranteed: Actual savings depend on successful dispatch and the applicable tariff.

Frequently Asked Questions About Peak Shaving Battery Sizing

These questions come up often once a facility starts peak shaving battery sizing from its own interval data.

Can I size a peak shaving battery from a utility bill?

A bill shows billed demand and charges, but it usually will not show the full duration and shape of the peaks. First, use interval data for a credible power-and-energy estimate. Then apply the tariff to evaluate savings.

Is a 100 kW battery enough to reduce my peak by 100 kW?

Not necessarily. First, it must deliver that power at the relevant point in the electrical system. Also, it needs enough energy and state of charge for the whole event. Finally, it must stay available for other peaks that affect the bill.

How many hours of battery storage do I need for peak shaving?

There is no universal duration. First, calculate the energy above your chosen demand target across actual events. Then test whether the proposed power and energy ratings can meet those events repeatedly.

Is peak shaving battery sizing the same as backup sizing?

No. Peak shaving battery sizing follows measured site demand above a grid-import target. Backup sizing starts instead with the critical loads that must run during an outage, and the required backup duration. It is a different starting point and a different formula set. For preliminary outage-backup estimates, use SunLith’s C&I BESS sizing calculator. It uses critical-load and backup-duration inputs, so it should not be used to size a peak-shaving system.

This article gives a preliminary sizing method, not an equipment specification or a savings guarantee. Final selection still needs interval-data and tariff analysis, electrical design, and product-specific validation.

Need a Peak-Shaving BESS Assessment?

A preliminary battery size should be tested against your actual interval demand data, tariff rules, charging windows, and operating priorities. Send SunLith your site load profile and utility tariff for an initial C&I BESS assessment.

Request a Preliminary Peak-Shaving BESS Assessment

SunLith can provide a preliminary assessment; final system design requires site-specific electrical, tariff, interconnection, and safety review.

Further Reading on Peak Shaving Battery Sizing

These SunLith guides cover the cost and strategy questions that follow once preliminary power and energy numbers are in hand.

SunLith Energy C&I BESS sizing calculator dashboard showing kW and kWh results

C&I BESS Sizing Calculator: Formulas, Free Tool, and a Worked Example

A C&I BESS sizing calculator answers one question fast. How big should the battery and inverter be?

It turns your critical load and backup hours into two numbers. First, installed battery energy in kWh. Second, PCS power in kW.

Use the free calculator below for a preliminary estimate. Then review the formulas, assumptions, and worked example before making project decisions.

Quick Answer: A C&I BESS sizing calculator turns your critical load and backup hours into two numbers. Installed battery energy in kWh factors in depth of discharge and round-trip efficiency. PCS power in kW adds a safety margin to your critical load. Still, this is a preliminary size, not a final design.

Try the C&I BESS Sizing Calculator

This calculator runs instantly in your browser. Once you enter a few numbers, it returns a preliminary size.

Enter your peak site load, critical load, and backup duration below. Then adjust depth of discharge, round-trip efficiency, and reserve margin if you have better numbers than the defaults.

C&I BESS Sizing Calculator

Estimate preliminary BESS power (kW/MW), installed battery energy (kWh/MWh), usable capacity, and backup duration.

Checks that critical load is realistic. It does not set PCS size unless whole-site backup is required.
Load that must operate during an outage.
Preliminary assumption. Final design should use discharge-path losses and auxiliary loads.
Advanced assumptions

The results show recommended PCS power and installed battery energy. They also show usable capacity, minimum apparent power, and the required C-rate.

It works on desktop and mobile browsers alike, with no signup and no limit on how many times you recalculate.

Preliminary sizing only. This calculator estimates battery energy and PCS power from the inputs you provide. It is not a final design, quotation, or performance guarantee. It also does not replace an interconnection study, fire-safety review, or full interval-load analysis.

Why C&I BESS Sizing Matters for Commercial and Industrial Sites

Demand charges and outage risk both push sites toward battery storage. So a C&I BESS sizing calculator earns its place from the first estimate.

But get the size wrong, and the cost shows up either way.

Demand charges can be steep. In fact, research from the National Renewable Energy Laboratory (NREL), cited in this NYSERDA research summary, puts them at 30 to 70 percent of a typical commercial bill.

For example, an undersized battery cannot cover the critical load for the full outage. An oversized one, meanwhile, ties up capital that could fund other work.

A sizing calculator will not replace formal engineering design. But it still gives you a fast, defensible starting point.

Many C&I storage decisions, in turn, weigh demand-charge savings alongside backup value, though actual payback varies widely by project, utility rate structure, and site load profile.

What This C&I BESS Sizing Calculator Estimates

This calculator has one job: outage backup. Enter a critical load and a backup duration. Then it returns a preliminary size.

It is not a peak-shaving calculator. Instead, peak shaving needs interval load data and your utility’s demand-charge structure, not just a critical load.

Cutting demand charges is a different goal. See our guide to C&I BESS peak shaving instead.

Facility managers, EPCs, and asset owners typically use this stage of sizing before requesting formal quotes from vendors.

How to Find Your C&I BESS Sizing Calculator Inputs

Most sizing mistakes start with the inputs, not the formulas. Get these right first, and the C&I BESS sizing calculator results are far more reliable. Rough numbers are fine at this stage; precise numbers can wait for the engineering phase.

Critical load: list every circuit that must run through an outage. Think life-safety systems, refrigeration, servers, security, and any process equipment that cannot tolerate downtime. Then sum their running kW, not nameplate or inrush kW.

Peak site load: pull this from 12 months of utility interval data if you have it. Otherwise, use your utility bill’s peak demand figure as a starting point.

Backup duration: match this to your actual outage risk, not a round number. A site with frequent short outages needs a different duration than one preparing for extended grid events, so review recent outage history if it exists.

Site documentation, meanwhile, helps too. Single-line diagrams, panel schedules, and recent utility bills all help validate your critical-load list before you finalise it.

Power factor and reserve margin, by contrast, are usually starting assumptions rather than measured figures. Adjust them once your battery vendor or EPC confirms real numbers.

The Sizing Formulas Behind the Calculator

SunLith Energy Diagram of C&I BESS sizing calculator formula flow from critical load to battery size

Every result from this C&I BESS sizing calculator comes from one of the formulas below. Here is what each one does, and why it matters.

Delivered Backup Energy

Delivered backup energy is critical load multiplied by backup hours. A 300 kW critical load for four hours, for example, needs 1,200 kWh delivered.

In short, this is the energy your equipment actually uses. It is not yet the battery size, since no battery discharges every stored kWh.

A facility with several critical circuits should sum them before running this figure.

Installed Battery Energy

Installed battery energy has three steps. First, divide delivered energy by depth of discharge. Then divide again by round-trip efficiency. Finally, add a reserve margin.

Together, DoD and RTE shrink how much nameplate capacity you can actually use. The reserve margin, meanwhile, covers degradation, temperature, and load uncertainty.

Most C&I LFP batteries run 85 to 95 percent depth of discharge. Round-trip efficiency usually sits between 90 and 95 percent at the system level. Always confirm this with your manufacturer’s datasheet.

Round-trip efficiency is a simplified, conservative assumption for a preliminary calculator. Final backup sizing should instead use discharge-path efficiency. That includes PCS, transformer, cable, battery, and auxiliary-load losses at the actual operating condition.

A wider site temperature range usually pushes real-world RTE toward the lower end of that band.

Recommended PCS Power and Apparent Power

Similarly, recommended PCS power is critical load times one plus a power margin. A 10 percent margin is a preliminary allowance only, and motor starting or other transient loads still need separate review.

Minimum apparent power in kVA, meanwhile, divides that PCS power by your system power factor. This is the screening figure for PCS and transformer ratings.

A lower power factor raises the apparent-power requirement, which can affect transformer selection.

C-Rate and Nominal E/P Duration

Finally, required C-rate is PCS power divided by installed battery energy. It shows how hard you are asking the battery to discharge.

Nominal E/P duration, by contrast, is installed battery energy divided by PCS power. Watch this figure closely. It often differs from your target backup hours, since DoD, RTE, and reserve margin all pull it away from a clean match.

A lower target C-rate generally means a larger, more conservative battery for the same PCS power.

CalculationFormulaMeaning
Delivered backup energy (kWh)Critical load (kW) × backup duration (hours)Energy the critical load needs during the outage.
Installed battery energy (kWh)(Delivered ÷ (DoD × RTE)) × (1 + reserve margin)Nominal capacity required after DoD, system efficiency, and reserve margin.
Usable battery capacity (kWh)Installed battery energy × DoDEnergy within the chosen discharge window.
Recommended PCS power (kW)Critical load × (1 + power margin)Suggested continuous PCS output rating.
Minimum apparent power (kVA)Recommended PCS power ÷ power factorScreening value for PCS and transformer rating.
Required C-rateRecommended PCS power ÷ installed battery energyPower-to-energy relationship indicator.
Nominal E/P duration (hours)Installed battery energy ÷ recommended PCS powerConfiguration indicator, not a runtime guarantee.

A C&I BESS Sizing Calculator Worked Example: 300 kW Critical Load

SunLith Energy Worked example infographic for a 300 kW critical load BESS sizing calculation

This worked example uses an 800 kW peak load and a 300 kW critical load. Backup duration is four hours.

Assumptions: 85% depth of discharge, 90% round-trip efficiency, 15% reserve margin. Also: 10% power margin, 0.90 power factor.

  • Delivered backup energy: 300 kW × 4 hours = 1,200 kWh.
  • Installed battery energy: (1,200 ÷ (0.85 × 0.90)) × 1.15 = 1,804 kWh, roughly 1.80 MWh.
  • Usable battery capacity: 1,804 × 0.85 = 1,533 kWh.
  • Recommended PCS power: 300 × 1.10 = 330 kW, or 0.33 MW.
  • Minimum apparent power: 330 ÷ 0.90 = 367 kVA, or 0.37 MVA.
  • Required C-rate: 330 ÷ 1,804 = 0.18C.
  • Nominal E/P duration: 1,804 ÷ 330 = 5.5 hours. That’s longer than the 4-hour target. DoD, RTE, and reserve margin together explain the gap.
  • This C&I BESS sizing calculator worked example uses one input combination. Change the backup duration to 2 hours, and installed battery energy roughly halves.
  • Push reserve margin to 20 percent instead, and it grows a little further. Run a few combinations of your own before settling on a target range.

Common C&I BESS Sizing Calculator Mistakes

These mistakes show up again and again in early estimates. But each one is easy to avoid once you know to check for it, and most take only a few extra minutes to correct before you share a number with anyone.

  • Ignoring DoD and RTE. In practice, sizing straight off delivered energy leaves a battery that cannot actually deliver the promised backup.
  • Skipping the reserve margin. Batteries lose usable capacity over time. A 10 to 15 percent margin, therefore, buys headroom for later years, not just day one.
  • Confusing power and energy. In short, a 330 kW PCS and a 1,804 kWh battery answer two different questions. Size both instead of just one.
  • Ignoring the required C-rate. For instance, a high C-rate can raise thermal stress and cut usable capacity under load. It can also affect cycle life and fall outside warranty limits. Confirm your chosen battery and PCS support the required rate.
  • Skipping fire code and siting review. NFPA 855, local fire and building codes, the authority having jurisdiction, and UL 9540A test evidence can all affect separation distances and layout. A preliminary estimate still needs a compliant site review. See our NFPA 855 guide for more detail.
  • Using nameplate load instead of running load. Nameplate and measured running load serve different purposes. Size the C&I BESS sizing calculator energy inputs off measured running kW, but review starting and transient loads separately for PCS sizing.
  • Skipping a sensitivity check. Run the calculator twice: once with conservative assumptions, once with optimistic ones. The gap between the two shows how much margin your estimate really has.

When You Need More Than a C&I BESS Sizing Calculator

Peak shaving, tariff optimisation, solar shifting, and generator integration all need more than one critical-load input. So do data centres and microgrids.

Peak shaving needs interval load data and your target demand level. Our demand charge guide covers why that line item is often 30 to 70 percent of a commercial bill.

Treat this calculator’s output as a starting point instead. Overall, bring it to an engineer, not to a procurement order.

Solar-plus-storage sizing is another case this C&I BESS sizing calculator does not cover. A hybrid system needs production profiles, self-consumption targets, and export limits alongside backup requirements.

Multi-building campuses work differently too. Size each building’s critical load separately, then combine the installed-energy totals rather than averaging duration targets across buildings.

Frequently Asked Questions

Quick answers to the most common C&I BESS sizing calculator questions, covering inputs, assumptions, and accuracy.

What inputs does a C&I BESS sizing calculator need?

At minimum: peak site load, critical load, and backup duration. Depth of discharge, round-trip efficiency, reserve margin, power margin, and power factor refine the estimate further.

What depth of discharge and round-trip efficiency should I use for LFP?

Most C&I LFP systems run 85 to 95 percent usable depth of discharge. Round-trip efficiency is usually 90 to 95 percent at the system level. Still, confirm exact figures with your manufacturer’s datasheet.

How much reserve margin should I add?

10 to 15 percent is a common starting point. It covers degradation, temperature swings, and load uncertainty. Still, longer contracts or harsher climates justify a larger margin.

Is a C&I BESS sizing calculator accurate enough for procurement?

No. Treat it as a preliminary estimate instead. Final sizing needs interval-load analysis, electrical design, site conditions, grid requirements, and product-specific warranty terms.

What’s the difference between installed and usable battery capacity?

Specifically, installed capacity is the nominal or nameplate energy capacity selected for the system. It is sized above the delivered-load requirement to account for DoD, system efficiency, and reserve margin. Usable capacity, by contrast, is the portion available within the selected DoD window.

Can this calculator size a multi-building campus?

Not directly in one pass. Run it once per building using each building’s own critical load and backup duration, then combine the installed-energy results before selecting a shared BESS.

How often should I re-run the calculator during a project?

Re-run it whenever a key input changes, such as an updated critical-load list, a revised backup target, or new DoD and RTE figures from a vendor quote. Treat early results as a starting range, not a fixed number.

Does this calculator account for battery degradation over time?

The calculator does not explicitly model year-by-year degradation. Its reserve margin is a user-selected allowance, not a validated end-of-life guarantee. Actual fade depends on chemistry, duty cycle, temperature, and your warranty terms.

Further Reading

More Sunlith guides pair well with this C&I BESS sizing calculator, covering fire code compliance, demand charges, and cost planning for C&I storage projects generally.

Disclaimer: This calculator and article provide preliminary estimates only. Final BESS sizing requires interval-load analysis, electrical engineering design, site assessment, applicable grid and fire codes, and manufacturer-specific validation.

SunLith Energy BESS grid connection studies load flow short circuit harmonics RMS EMT modelling

BESS Grid Connection Studies: Load Flow, Short-Circuit, Harmonics, RMS and EMT Modelling

BESS grid connection studies are the engineering checks a network operator runs before it approves a battery storage project. Each study asks the same underlying question: can this plant connect and operate without exceeding voltage, thermal, fault-level, protection, or power-quality limits at the connection point? This guide covers the core BESS grid connection studies: load flow, short-circuit, protection coordination, harmonics, and RMS/EMT dynamic modelling.

Last reviewed: September 2026. Study requirements vary by network operator, project design, grid strength, and applicable grid code.

This guide walks through:

  • What each of the core study types actually checks
  • Why RMS and EMT modelling are different tools, not two names for the same thing
  • Where these studies sit inside the wider interconnection timeline
  • What a BESS developer needs to supply before a network operator can run them
  • Common reasons a study package gets rejected or delayed

Quick Answer

BESS grid connection studies are the technical checks a network operator runs before interconnection: load flow, short-circuit, harmonics, and RMS/EMT dynamic modelling. Together, they confirm a battery project can connect safely, without degrading voltage, fault protection, or power quality on the connecting network.

BESS Grid Connection Studies Checklist

Before locking the BESS configuration or signing a PCS supply agreement, work through this checklist.

  • Identify the likely point of connection, voltage level, and export/import capacity
  • Obtain the network operator’s formal study scope, model format, and submission timeline
  • Confirm whether the plant must operate grid-following, grid-forming, or both
  • Obtain validated RMS models, and EMT models where required, for the PCS and plant controller
  • Confirm the model’s operating range, control modes, fault-response logic, and firmware version
  • Screen local grid strength, nearby inverter-based resources, and background harmonic levels early
  • Reserve schedule time for model review, study reruns, and compliance testing
  • Carry a contingency for mitigation measures such as filtering, a revised export limit, or grid-forming controls

What Are BESS Grid Connection Studies?

BESS grid connection studies answer one question. Can this project connect here safely? The network operator studies the plant at its point of interconnection (POI), sometimes called the point of common coupling (PCC). It then compares the results against the planning limits already set for that part of the grid.

Specifically, study scope depends on three main factors: project size, connection voltage, and how electrically “stiff” or “weak” the network already is. For instance, a small distribution-connected project may only need a load flow and a short-circuit study. A large transmission-connected BESS at a weak point of connection may require a broader package, including load flow, short-circuit, protection, harmonic, RMS dynamic, and potentially EMT studies. Our guide to the BESS interconnection process covers where this study stage sits inside the wider application-to-commissioning workflow.

Why BESS Grid Connection Studies Don’t Follow One Fixed Order

Network operators often organise BESS grid connection studies in phases, but not always in a strict, one-way order. Early load flow and short-circuit work usually establishes basic connection feasibility first. Protection, harmonics, RMS, and EMT studies can run in parallel, or get repeated, as the selected PCS, transformer, plant controller, and operating limits become clearer. Treat the study package as an iterative engineering process, not a single pass through a checklist.

Load Flow: The First of the BESS Grid Connection Studies

SunLith Energy BESS grid connection studies typical phases load flow short circuit protection harmonics RMS EMT

A load flow study is also called a power flow study. It models the network in its normal, steady-state condition, with the new BESS connected. The question is simple. Will voltages and equipment loading stay inside acceptable limits once this plant is added?

In addition, the study represents the BESS plant in full detail rather than as one generic source. A proper power flow model includes the generator tie line, the main step-up transformer, the collector system, and the plant’s reactive power range at every output level, from full charge to full discharge. A BESS is a four-quadrant device, so the study checks both directions of power flow. Therefore, it does not simply evaluate export power.

What a Load Flow Study Looks For

  • Thermal loading on lines, cables, and transformers under peak import and export
  • Voltage rise and voltage drop across the connection, under different dispatch scenarios
  • Whether existing voltage-regulation equipment, like tap changers, still works correctly
  • Reverse power flow conditions that did not exist before the BESS connected
  • The reactive power range the plant must hold to keep voltage inside its schedule

In practice, a voltage or thermal violation usually leads to revised operating limits, network reinforcement, or design changes that get assessed in a further study iteration, rather than an outright rejection. This is a normal, expected part of BESS grid connection studies, not a sign the project has failed.

Short-Circuit Studies for BESS Grid Connection

A short-circuit study is also called a fault-level study. It calculates how much current would flow during a fault, at different points on the network, both with and without the BESS connected. The network operator uses this to confirm existing switchgear, relays, and conductors can still safely handle a fault once the new plant joins the system.

BESS fault behaviour differs from a conventional generator’s fault behaviour in a real way. A synchronous machine’s fault current is limited mainly by its own impedance, and it can spike to several times rated current for a brief period. A BESS PCS instead limits fault current through its own control and protection logic. As a result, the magnitude, sequence components, duration, and active-versus-reactive current priority can all vary by inverter design, grid code, control mode, fault type, and voltage conditions. This distinction matters for protection coordination. Protection designed around conventional-generator assumptions may lose sensitivity, selectivity, or coordination once the connected resource has inverter-limited fault-current behaviour.

Maximum and Minimum Fault Levels in BESS Grid Connection Studies

A thorough short-circuit study calculates two separate cases, not one. The maximum fault level, using the highest credible fault current, confirms equipment ratings are not exceeded. The minimum fault level, using the lowest credible fault current, confirms protection relays still see enough current to clear a fault reliably. One international standard covers the underlying AC-side calculation method in detail: IEC 60909, developed for AC short-circuit currents generally and increasingly applied to BESS/PCS fault contribution. A separate standard, IEC 61660, covers fault calculations in station DC and auxiliary DC systems. That’s relevant to a BESS’s own DC-side protection design, but it is separate from the AC grid-fault analysis that normally forms part of a network operator’s interconnection study. The same IEC technical committee developed both.

Protection Coordination in BESS Grid Connection Studies

Protection coordination is often scoped as its own study, separate from the short-circuit calculation itself. The short-circuit study sets the fault-current numbers. Meanwhile, the protection study decides what the relays actually do with those numbers.

The network operator checks that protection isolates a fault selectively, tripping the minimum necessary equipment while maintaining coordinated backup protection where required. Protection must also stay secure during external events, riding through rather than clearing. This gets more involved with a BESS on the feeder. Its current contribution is shaped by inverter control logic, not fixed machine impedance.

What a Protection Study Checks

  • Relay grading and trip-curve settings across the feeder, with the BESS included
  • Whether protection stays selective, so only the closest device clears an internal fault
  • Anti-islanding detection and response
  • Current-transformer and voltage-transformer sizing against the new fault-current profile
  • Coordination margins between the BESS’s own protection and the network operator’s relays

A February 2026 National Energy System Operator (NESO) guidance document on RMS and EMT model requirements identifies overvoltage and undervoltage protection, over- and under-frequency protection, and DC bus voltage and current protection as functions that should be represented where relevant to the inverter-based resource, modelled for both balanced and unbalanced fault conditions. That level of protection detail needs to reach the study, not just sit in the PCS vendor’s own product documentation.

Harmonics: The Power-Quality Piece of BESS Grid Connection Studies

A harmonics study checks waveform quality at the connection point, not just its magnitude. A battery inverter switches at high frequency to convert DC to AC. That switching process injects some waveform distortion back into the grid, alongside its intended fundamental-frequency output.

Two related metrics matter here. Voltage THD (total harmonic distortion) expresses the RMS value of harmonic voltage components relative to the fundamental voltage. Current TDD (total demand distortion) expresses RMS harmonic current relative to the maximum demand load current, rather than the instantaneous fundamental current, which keeps the limit meaningful at light-load conditions too. Both voltage and current distortion can technically be expressed as THD, but in the US, IEEE 519 commonly uses TDD specifically for evaluating current distortion at the point of common coupling. Network operators may also assess individual harmonic components, interharmonics, resonance, and planning levels beyond these two headline figures. Internationally, IEC/TR 61000-3-6 gives a comparable framework for assessing harmonic emission limits when connecting a distorting installation, inverter-based generation included, to medium, high, and extra-high voltage systems.

Why Inverter-Based Resources Change the Harmonics Picture

A single small inverter rarely causes a measurable problem on its own. However, a utility-scale BESS plant is different. So is a feeder where BESS and solar PV share the same connection point. Harmonic currents from multiple sources can add together at certain frequencies, rather than simply cancel out. The available fault current at the connection point also affects how much voltage distortion a given harmonic current actually produces, which is why harmonics work is closely tied to the short-circuit study rather than assessed in isolation. A weaker fault level turns the same harmonic current into a larger voltage distortion.

RMS and EMT Dynamic Modelling for BESS Grid Connection Studies

RMS and EMT are the two simulation domains used to study how a BESS plant behaves during a disturbance, not just at steady state. They answer different questions, at different levels of detail. A network operator usually specifies which one it needs based on how electrically weak the connection point already is.

First, RMS modelling stands for root-mean-square, or phasor-domain, simulation. It represents the network using simplified fundamental-frequency phasors. It tracks how power, voltage, and frequency evolve over seconds to minutes. So RMS is efficient enough to study a large interconnected network. It is the standard tool for frequency response, voltage stability, and wide-area planning work.

Conversely, EMT modelling stands for electromagnetic transient simulation. It represents the actual instantaneous waveform, not a simplified phasor. It captures behaviour on the scale of microseconds to milliseconds. Even so, EMT is far more demanding to compute, which limits it to a smaller network area. It is generally the preferred domain for capturing fast inverter control-loop interactions, detailed unbalanced-fault behaviour, switching transients, and other sub-cycle dynamics that a simplified RMS model may not capture adequately.

When EMT Modelling Becomes Necessary

A 2023 NERC reliability guideline on BESS and hybrid plant modelling identifies low short-circuit strength, interaction risk among multiple inverter-based resources, and grid-forming control as important situations where detailed EMT assessment may be appropriate. The final requirement stays project- and network-operator-specific. Still, RMS models stay adequate for most standard planning and screening work. Even so, network operators increasingly ask for both. RMS handles the broad system-wide screening. EMT handles the specific, electrically sensitive area near the new plant.

For the country-specific grid-code obligations these studies are designed to demonstrate, see our BESS Grid Codes and Compliance guide.

RMS vs EMT at a Glance

SunLith Energy RMS versus EMT modelling comparison for BESS grid connection studies
FactorRMS (Phasor-Domain)EMT (Electromagnetic Transient)
Time scaleSeconds to minutesMicroseconds to milliseconds
RepresentsSimplified fundamental-frequency phasorActual instantaneous waveform
Typical useFrequency response, voltage stability, wide-area planningWeak-grid behaviour, control interactions, protection response
Network sizeLarge, interconnected systemsSmaller, localized network area
Computational costLowerConsiderably higher
Model sourceVendor-supplied standardised dynamic modelVendor-supplied detailed EMT model

System Strength and Weak-Grid Considerations

System strength describes how firmly the local network holds its voltage and frequency steady when a disturbance hits. A weak point of connection has relatively high impedance. That makes it more sensitive to fast inverter-control action, not less.

Indeed, a BESS can genuinely help a weak grid, especially with a well-designed voltage-control or grid-forming PCS. But connecting at a weak point still raises real risks. The study package needs to catch control-loop instability in grid-following inverters, conflicts between current limits and voltage support, harmonic amplification, and slower fault ride-through than a stronger point would show.

Grid-Forming Controls Don’t Automatically Fix a Weak Grid

Grid-forming capability has to be assessed against three things: the specific operating mode the network operator requires, the protection design, and how the plant interacts with other inverter-based resources nearby. It is one mitigation option among several, not an automatic pass. Our Australia BESS grid connection guide covers how one network operator assesses system strength and grid-forming capability in practice, including where AEMO’s own guidance applies.

How BESS Grid Connection Studies Fit Into the Interconnection Timeline

These study types do not run on their own. They sit inside one defined stage of the wider interconnection process. That stage generally follows the initial application and feasibility screening, but comes before a formal connection agreement. Our BESS interconnection process guide covers this full sequence step by step. The country guides for Australia, the UK, and Europe each show how local network operators schedule this stage in practice.

What a Developer Must Supply for BESS Grid Connection Studies

The network operator cannot run a meaningful study without accurate models from the project side. A model that does not match the as-built equipment is one of the most common reasons a study result later fails to match real commissioning-test behaviour. A typical model-deliverable package includes:

  • PCS RMS model in the network operator’s required format
  • EMT model, where requested or reasonably anticipated
  • Plant-controller model and parameter file
  • Inverter control-mode descriptions and operating limits
  • Transformer vector group, impedance, tap range, and grounding data
  • Cable and collector-system parameters
  • Protection single-line diagram and proposed relay settings
  • Reactive-power capability curve
  • Harmonic emission spectrum or equivalent frequency-domain data
  • Firmware, model, and controller version numbers
  • Model validation report and revision history

Common Pitfalls in BESS Grid Connection Studies

Most delays in a BESS grid-study package trace back to a small set of recurring issues. In fact, few come from a genuinely hard technical problem.

Common Study Failures and How to Avoid Them

FailureWhy It HappensHow to Prevent It
Studies start with only generic inverter dataThe selected PCS or control configuration isn’t final yetUse generic data for early screening only; replace it with validated project-specific models before final submission
Charging mode gets treated as secondaryTeams model export in detail but skim over maximum import and reactive-only casesInclude charging, discharging, standby, and reactive-only cases from the start
Co-located equipment gets left outNearby solar, capacitor banks, and cables all shift the dynamic and harmonic pictureModel the full plant and any electrically relevant equipment nearby
A model is submitted unvalidatedThe network operator can’t reproduce the plant’s expected behaviourRequire validation evidence and parameter traceability from the PCS supplier
Late firmware changes go unreportedThe installed controls no longer match the approved modelUse formal change control, and resubmit for study when material settings change

How Study Results Affect BESS Cost and Revenue

Grid connection studies aren’t just a technical hurdle; instead, their results feed straight into the project’s business case. A study can change several things at once. The substation and protection scope. The PCS rating actually needed. Whether harmonic filtering or extra reactive-power equipment gets added. The final export or import capacity the plant is allowed.

A project designed around a 100 MW PCS might come out of studies with only 80 MW of firm export capacity. Or it might carry a reactive-power reservation that reduces available active power at certain voltage conditions. Each of those changes affects CAPEX, usable revenue capacity, and lifetime project economics. So study results should inform the financial model before procurement is finalised, not after.

For the cost and revenue side of that picture, see Sunlith’s guides to BESS CAPEX calculation, BESS OPEX and operating cost modelling, and BESS revenue streams and value stacking.

Comparing the Core BESS Grid Connection Studies

StudyDomainCore QuestionTypical Trigger
Load flowSteady stateDo voltage and thermal limits hold with the plant connected?Most grid-connected projects
Short-circuitFault conditionDoes fault current stay within equipment and protection limits?Common for projects requiring detailed technical review
Protection coordinationFault responseDoes protection stay selective and secure with the BESS added?Where protection settings, fault duty, or anti-islanding could be affected
HarmonicsWaveform qualityDoes distortion stay within planning levels at the connection point?Common for inverter-based systems, where required by the operator or power-quality standard
RMS/EMT dynamicTransient/dynamicDoes the plant stay stable through disturbances and control interactions?More likely for large, weak-grid, grid-forming, or transmission-connected projects

Frequently Asked Questions

Common questions readers ask about BESS grid connection studies, answered directly.

Does every BESS project need all of these grid connection studies?

Not always. Smaller distribution-connected projects on a strong network often only need load flow, short-circuit, and protection coordination studies. Harmonics and dynamic RMS/EMT studies become more likely as project size grows, as the connection point gets weaker, or as the project uses grid-forming controls. Confirm the required scope with the relevant network operator.

Who actually performs BESS grid connection studies?

The network operator, or transmission owner, typically runs the studies. It uses models the developer’s equipment vendors and system integrator supply. Some markets let a developer commission an independent, accredited study provider for part of the work, subject to the operator’s review.

What’s the real difference between RMS and EMT modelling?

RMS modelling represents slower power-system dynamics using simplified phasors. In contrast, EMT modelling represents the actual instantaneous waveform, capturing much faster behaviour down to microseconds. EMT suits weak-grid and control-interaction studies that RMS cannot see in enough detail.

Why does a BESS need its own short-circuit study, instead of using generic generator data?

A battery inverter’s fault current is limited by its control system, not by machine impedance, so it behaves differently from a synchronous generator during a fault. Reusing generic synchronous-generator assumptions for a BESS can misrepresent both the maximum and minimum fault-current cases that protection settings depend on.

How long does a full grid connection study package take?

Timelines vary by market, network operator workload, and study complexity. They can range from a few weeks for a simple load flow and short-circuit package, to many months where full RMS and EMT modelling is required. Treat any timeline as a planning estimate, and confirm current queue times with the relevant network operator.

What happens if a project fails a grid connection study?

A failed result rarely ends the project outright. So the network operator usually proposes a fix instead, such as a lower export limit, added reactive power support, network reinforcement, or a different control-mode requirement. The project is then re-studied against the revised assumptions. Rejection outright is uncommon in real BESS grid connection studies.

Do harmonics studies apply differently to a BESS than to solar PV?

The underlying inverter switching behaviour is similar. But a BESS charges and discharges across a four-quadrant range, so its harmonic contribution needs checking across a wider set of operating points than a generation-only solar PV plant, which only ever exports.

Does a grid-forming BESS need a different study approach?

Often, yes. Grid-forming BESS projects are more likely to require detailed EMT assessment, because control-loop, current-limit, and fault-response behaviour can matter a great deal in weak-grid conditions. RMS modelling may still cover the broader system studies, but the network operator may separately require EMT evidence for the local interaction assessment.

Can a firmware update trigger a new grid connection study?

Yes. If a firmware change alters protection behaviour, current limits, grid-forming logic, fault ride-through, or reactive-power control, the network operator may require a fresh assessment or an updated model. Treat firmware updates on commissioned equipment as controlled engineering changes, not routine maintenance.

Glossary

More Sunlith Energy definitions for terms used throughout this BESS grid connection studies guide.

Study and Network Terms

Load flow (power flow) study — A steady-state check of voltage and equipment loading across the network, with a new plant connected.

Short-circuit (fault-level) study — A check of fault current magnitude at points across the network, used to confirm equipment and protection ratings.

POI (point of interconnection) — The physical point where a generating plant connects to the wider network.

PCC (point of common coupling) — The point on the network, often the same as the POI, where harmonic and power-quality limits get assessed.

System strength — How firmly a local network holds voltage and frequency steady when a disturbance occurs; a low-strength, or “weak,” connection point is more sensitive to fast inverter-control action.

Modelling and Power-Quality Terms

RMS modelling — Phasor-domain simulation used to study slower power-system dynamics, over seconds to minutes.

EMT modelling — Electromagnetic transient simulation used to study fast, instantaneous waveform behaviour.

THD (total harmonic distortion) — The RMS value of harmonic voltage (or current) components relative to the fundamental. Commonly used for voltage distortion at the connection point.

TDD (total demand distortion) — RMS harmonic current relative to the maximum demand load current, not the instantaneous fundamental current. IEEE 519 commonly uses this for current distortion.

Disclaimer

Important: This guide is general technical information, not project-specific engineering advice. Study requirements, thresholds, and timelines vary by network operator, connection voltage, project size, and jurisdiction. Confirm the required study scope and current standards with the relevant network operator, and a qualified electrical or grid-connection engineer, before relying on any figure here for a real project.

Further Reading

More Sunlith Energy guides on BESS interconnection, grid codes, and short-circuit standards.

Sources and Technical References

Primary and external sources cited in this article.

1. NERC, “Reliability Guideline: Performance, Modeling, and Simulations of BPS-Connected Battery Energy Storage Systems and Hybrid Power Plants,” June 2023.

2. IEEE Std 519-2022, “IEEE Recommended Practice and Requirements for Harmonic Control in Electric Power Systems.”

3. IEC, “IEC/TR 61000-3-6:2008 — Electromagnetic compatibility (EMC) – Part 3-6: Limits – Assessment of emission limits for the connection of distorting installations to MV, HV and EHV power systems,” 2nd edition.

4. National Energy System Operator (NESO), “Frequently Asked Questions on Root Mean Square (RMS) and ElectroMagnetic Transient (EMT) Model Requirements,” February 2026.

SunLith Energy Europe BESS grid connection map showing EU member states and the RfG framework

Europe BESS Grid Connection: EU RfG and Country Guide

A Europe BESS grid connection depends on the country where the project is located within the European Union, not just its size or voltage. The EU-wide Requirements for Generators (RfG) regulation provides a common technical baseline. But each country runs its own transmission system operator, its own national grid code, and its own connection process. So the practical route, and the risk of delay, can differ sharply between markets that share the same underlying EU rules.

Scope note: This guide covers the EU-wide RfG framework, then spotlights four of Europe’s largest BESS markets: Germany, Spain, Italy, and the Netherlands. The United Kingdom sits outside the EU and follows its own framework, covered in a separate guide. Norway and Switzerland connect into the same ENTSO-E system but sit outside the EU too, and are not covered in detail here.

Quick answer: A BESS grid connection in the EU starts with the Requirements for Generators (RfG) framework, but the real route is decided nationally. The relevant TSO or DSO applies its own country-specific grid code, connection process, capacity-allocation rules, studies, and compliance tests. Germany, Spain, Italy, and the Netherlands each face significant connection pressure right now, so confirm current queue, congestion, and permitting requirements with the relevant network operator before fixing a schedule or equipment specification.

So, this guide walks through:

  • How the EU-wide RfG framework sets a common technical baseline across member states
  • Who governs a Europe BESS grid connection at the EU level and the national level
  • How the connection process generally works, stage by stage
  • Country spotlights on Germany, Spain, Italy, and the Netherlands
  • The common thread across these markets, and how to reduce connection risk

Europe BESS Grid Connection Checklist

  • Confirm the country, connection voltage, network level, and applicable synchronous area, because RfG thresholds and national requirements vary.
  • Identify the likely RfG Power Generating Module Type (A, B, C, or D) for the project’s capacity and voltage.
  • Confirm whether the project connects to the national TSO or a regional DSO, and what that changes.
  • Check the national grid code’s specific requirements, since these can go well beyond the EU baseline.
  • Screen the country’s current connection-queue status, since several markets have overhauled their rules recently.
  • Ask the PCS supplier and system integrator for validated models in the format the network operator requires.
  • Allow schedule contingency for studies, national permitting, and grid-code compliance testing.

Who Governs a Europe BESS Grid Connection?

SunLith Energy Diagram of European Commission, ACER, ENTSO-E, national TSO and DSO roles in a Europe BESS grid connection

No single body runs a Europe BESS grid connection from end to end. Instead, EU-level bodies set the common framework, while national bodies run the actual connection process.

OrganisationMain role for BESS projects
European CommissionAdopts EU network codes, including RfG, as binding regulations across member states.
ACERThe EU Agency for the Cooperation of Energy Regulators. Recommends network codes and coordinates national regulators.
ENTSO-EThe European Network of Transmission System Operators. Coordinates technical implementation of RfG and related codes across national TSOs.
National TSOOperates the transmission grid and connects larger or transmission-voltage projects. The number and structure of TSOs vary by country; Germany, for example, has four.
National DSO(s)Operate regional or local distribution networks and connect most smaller and medium-sized projects. Often several per country.
National regulatorApproves connection rules and technical codes at the national level. Examples include Germany’s Bundesnetzagentur, Spain’s CNMC, Italy’s ARERA, and the Netherlands’ ACM.

So don’t assume ENTSO-E or the European Commission reviews individual projects. Instead, they set the common framework. In practice, the project deals mainly with the relevant TSO or DSO and, where applicable, the energy regulator.

Current detail from EU-level bodies: ENTSO-E’s RfG overview, ACER.

The EU-Wide Framework Behind a Europe BESS Grid Connection

RfG classifies Power-Generating Modules (PGMs) into Types A to D. For BESS projects in EU member states, this is the shared technical baseline behind most connection requirements.

TypeGeneral basisWhat it means in practice
Type ASmallest capacity, lowest voltageFewest technical requirements, often a simplified process
Type BSmall to medium capacityMore technical requirements than Type A, thresholds vary by country
Type CMedium to large capacityDetailed technical and testing requirements
Type DLargest capacity, or connects at high voltageMost extensive requirements, including full system studies

The exact MW thresholds between types are not identical across the EU, though. RfG sets upper limits for each synchronous area, but leaves the precise threshold within that band to the national level. So a project sitting near a threshold in one country may fall into a different type in another. Confirm the applicable type with the connecting TSO or DSO rather than assuming a single EU-wide number.

Battery storage adds a further wrinkle, and this is worth reading carefully. RfG was drafted around generation, and storage can be treated differently depending on the national implementation, the BESS’s operating mode, and its connection arrangement. In many member states, storage that exports to the grid is assessed using requirements aligned with the relevant PGM category, but developers should confirm the exact national treatment with the connecting TSO or DSO rather than assume it works identically to a conventional generator. National implementation of RfG can also add significant detail beyond the EU baseline, as our global BESS grid codes comparison shows.

How the Europe BESS Grid Connection Process Works, Stage by Stage

Treat the connection journey as a set of stages, not one checklist. The framework stays similar across countries, but the pace and detail vary a great deal, as the country spotlights below show.

Stage 1: Site Screening and Capacity Assessment

First, confirm the country, the likely point of connection, and whether that point sits on the transmission or distribution network. Then estimate the project’s likely RfG type, since this shapes both the technical requirements and the study scope ahead. Also screen the national connection queue early. As the country spotlights below show, several major markets are running queues many times larger than their planning assumptions. So realistic timing matters more than nameplate capacity alone.

Stage 2: Connection Application

Next, submit a connection application to the relevant network operator. That means the relevant TSO for transmission-network connections or larger projects, or the relevant DSO for many distribution-network connections. The application should identify the proposed site, capacity, connection voltage, and intended operating modes. Requirements for what to include vary by country, so check the specific network operator’s current application format rather than assuming one EU-wide template.

Stage 3: Studies and Compliance Verification

The network operator then sets the study scope. Larger or higher-type projects generally need load-flow, short-circuit, and dynamic-performance studies against the applicable national grid code. Many countries also require compliance documentation, certificates, or witnessed test evidence before energisation, where the national framework calls for it, confirming the installed plant meets the agreed technical requirements.

Treat model submission as real engineering, not paperwork. Ask the PCS supplier and system integrator for validated models in the format the network operator requires, together with controller logic and operating-mode assumptions, before finalising procurement.

See our guide on fault ride-through and LVRT/HVRT capability for more on the dynamic-performance side of this testing.

Stage 4: Connection Offer and Permitting

Both the network operator’s response and the surrounding permitting process vary significantly by country. In some markets, access and connection authorisations are processed through linked or coordinated procedures. In others, they are separate stages with their own timelines. Environmental and planning permits often run in parallel, and can end up the longer critical path on a large project. Confirm the current sequence with the relevant network operator and permitting authority early.

Stage 5: Construction and Commissioning

Commissioning confirms the installed plant matches the approved design. Expect to provide as-built documentation and protection settings, plus any certification or compliance evidence required by the national framework and network operator before energisation. Testing typically covers protection behaviour and, for larger or higher-type projects, dynamic performance against the applicable grid code.

Stage 6: Ongoing Compliance

Compliance does not stop once operation begins. Instead, changes to inverter firmware, protection settings, plant-controller logic, or other declared technical parameters can trigger a reassessment. So treat compliance documentation as an ongoing operational task, not a one-off commissioning step.

Realistic timelines vary enormously by country and by where a project sits in that country’s connection queue, application pipeline, or capacity-allocation process. A small, distribution-connected project can sometimes progress in months. A large, transmission-connected project in a congested market can take years, and several major markets are actively reworking their queue rules as this guide is written. Build schedule contingency around studies and queue position specifically, since both are the hardest parts to forecast right now.

For the general, country-agnostic version of this workflow, see our BESS interconnection process guide.

Country Spotlight: Germany

Germany runs four regional TSOs: 50Hertz, Amprion, TenneT Germany, and TransnetBW. Their number and structure are specific to Germany, not a Europe-wide pattern. Distribution-level projects instead connect through one of many regional DSOs. The national regulator is the Bundesnetzagentur.

Technical requirements come from the VDE-AR-N series: 4105 for low voltage, 4110 for medium voltage, and 4120 for high voltage, each implementing RfG in German-specific detail. Battery projects also typically need to meet VDE-AR-E 2510-50 for battery safety, alongside the relevant grid-connection code.

The connection process itself is changing. By the end of Q3 2025, Germany’s four TSOs had received 545 applications for large battery-storage systems representing 211 GW of requested capacity. That figure describes application volume, not contracted or construction-ready capacity, and it compares to a Grid Development Plan forecast of just 41 to 94 GW of large-scale storage by 2037.

In response, the TSOs jointly proposed a new maturity assessment procedure, the Reifegradverfahren, to move away from allocation based solely on application date, toward an evaluation based on land control, permitting status, technical readiness, and financial or commercial readiness. The procedure began its application phase on 1 April 2026. As of that announcement, the TSOs themselves noted that confirmation of the procedure’s legal basis by the Bundesnetzagentur was still advisable. So treat this as a live, TSO-led process still being formalised, rather than a settled legal framework, and confirm current requirements directly with the relevant TSO.

See: the four German TSOs’ joint press release on the maturity assessment procedure.

Country Spotlight: Spain

Spain has one national TSO, Red Eléctrica de España (REE), plus regional DSOs for distribution-level connections. Meanwhile, the national regulator is the Comisión Nacional de los Mercados y la Competencia (CNMC).

Since 2020, Spain has processed access and connection permits together. Developers submit a single joint application to REE or the relevant DSO, rather than two separate steps. During 2025, Spain’s storage-access framework underwent several changes. Royal Decree-Law 7/2025 included proposed measures relevant to storage access, but Congress rejected it on 22 July 2025, so it never took permanent legal effect. Related provisions were later introduced through Royal Decree 997/2025, approved on 5 November 2025, which also addressed how installed capacity is calculated for hybrid and standalone storage projects. Given this history, confirm the currently applicable rule directly with REE or CNMC rather than citing either decree from memory.

The scale of pent-up demand is striking. Published Spanish grid data has indicated a large pipeline of storage projects at different access, connection, and pre-commissioning stages, while commissioned battery capacity remains much lower, on the order of a few hundred MW. Check REE’s latest dataset before using any specific pipeline figure in a schedule or investment decision.

See: Royal Decree 997/2025 (BOE-A-2025-22434).

Country Spotlight: Italy

In Italy, Terna manages transmission-network connections, while regional distribution operators manage most distribution-network connections. In some circumstances, projects of 10 MW or more may be handled by Terna, but the responsible operator depends on the point of connection, voltage level, network configuration, and the applicable TICA provisions. ARERA, the national energy regulator, sets the technical and economic conditions for both, through the Testo Integrato delle Connessioni Attive (TICA). Confirm the route with the prospective network operator rather than relying on capacity alone.

Like Germany and the Netherlands, Italy is managing far more connection requests than its network was planned for. As of 31 May 2026, Terna’s Econnextion platform recorded roughly 294 GW of storage connection requests alone, well beyond national 2030 targets. In response, Decreto MASE 291/2026, signed 8 September 2026 and in force from 9 September 2026, requires Terna to divide the national transmission grid into microzone (microzones) and calculate available capacity for renewables and storage within each. The decree sets out a phased rollout: Terna must submit its microzone methodology to the ministry within 30 days of the decree taking effect, with the finalised microzones published within a further 15 days after approval. So treat the underlying capacity-allocation reform as legally in force, but the actual microzone boundaries and published capacity figures as still being rolled out through late 2026.

See: Decreto MASE 291/2026 (Italy’s Ministry of Environment and Energy Security).

Country Spotlight: Netherlands

The Netherlands has one national TSO, TenneT, plus regional DSOs for distribution-level connections. The Authority for Consumers and Markets (ACM) is the national regulator.

Grid congestion, known locally as netcongestie, is the defining issue for new connections in much of the country. TenneT’s own reporting has described a connection queue including tens of gigawatts of battery storage requests against a national peak load a fraction of that size.

In response, ACM authorised flexible capacity arrangements, including what TenneT calls the time-bound transmission right (TDTR) and the capacity control contract (CSC), under which a project may accept reduced or conditional access in exchange for network capacity or congestion-management value. A battery that can act as a controllable congestion mitigator, reducing strain on the grid at TenneT’s request under this framework, may receive preferential treatment under the applicable congestion-management or capacity-allocation framework. Confirm the exact contract type, availability, and eligibility conditions directly with TenneT or the relevant DSO, since this framework is still being extended to new regions and projects.

See: TenneT’s own account of its first congestion-mitigator contract.

Comparing Europe BESS Grid Connection Markets: Germany, Spain, Italy, and the Netherlands

SunLith Energy Comparison of Germany, Spain, Italy, and Netherlands BESS grid connection processes
CountryTransmission operatorMain connection issueCheck first
Germany4 regional TSOsHigh application volume, new maturity-based allocationApplicable TSO’s current process and connection point
SpainREEUnsettled storage-access rules, large pending pipelineREE/DSO access capacity and current permit route
ItalyTerna + regional DSOsCapacity allocation via new microzone systemConnection voltage and responsible operator
NetherlandsTenneT + regional DSOsWidespread congestion (netcongestie)Firm versus flexible capacity options

The Common Thread Across These Europe BESS Grid Connection Markets

Germany, Spain, Italy, and the Netherlands look different on the surface. Each has its own TSO structure, its own national code, and its own institutions. But they share a pattern worth noticing. Across all four, high volumes of storage and hybrid-project applications have increased pressure on connection processes. Network operators are increasingly using readiness evidence, technical feasibility, conditional-access arrangements, or other prioritisation tools, rather than relying solely on application date. The details differ materially by country and operator, and some of these changes are still being finalised as this guide is written.

For developers, that means two things. First, don’t plan a European BESS project around queue rules you read about even a year ago; they may already be out of date. Second, a project’s evidence of real readiness, land control, permits, financing, and validated technical models, increasingly matters as much as when it first applied.

Common Risks in a Europe BESS Grid Connection

Most delays in a Europe BESS grid connection trace back to a small set of repeat mistakes. So here is how to catch them early.

RiskConsequenceMitigation
Assuming one EU-wide threshold or process appliesWrong compliance pathway assumed earlyConfirm the national RfG type and process with the specific TSO or DSO
Relying on outdated queue-rule guidanceSchedule built on a process that no longer appliesCheck current queue and prioritisation rules directly with the network operator
Selecting a site before checking congestion statusNon-firm terms or multi-year delayScreen the country’s current congestion and queue data early
Incomplete or unvalidated dynamic modelsDelayed studies and commissioning reworkRequire validated models from the PCS vendor and integrator
Treating national code compliance as an afterthoughtDesign changes late in developmentConfirm the applicable national grid code early in concept design
Assuming permitting and connection run on the same timelineLand, environmental, or planning delays block an otherwise-ready connectionRun permitting and connection work in parallel from the start

Planning a BESS project in Europe? Start with a country-specific connection-readiness assessment. Cover the applicable RfG type, national grid code, current queue status, and permitting timeline, before you finalise equipment specifications.

Frequently Asked Questions About a Europe BESS Grid Connection

Common questions developers ask before choosing a European market or signing a connection agreement.

Does one EU grid code cover every country?

No. RfG sets a common EU-wide baseline, classifying projects into Types A to D. But each country implements it through its own national grid code, which can add significant detail, as Germany’s VDE-AR-N series shows. Confirm the national code alongside RfG, not instead of it.

Is the UK covered by this Europe BESS grid connection guide?

No. The UK sits outside the EU and follows its own framework, built around NESO, the Grid Code, and Engineering Recommendations G98/G99/G100. See our dedicated UK guide for that detail.

Which European countries have the longest BESS connection queues right now?

Germany, Italy, Spain, and the Netherlands have all reported connection queues many times larger than their official capacity targets. Each has introduced new prioritisation rules within the past two years to manage this, so treat queue length as a moving target, not a fixed number.

Does battery storage get classified the same way as solar or wind under RfG?

Often, but not automatically. Many national frameworks apply Type A-D-style requirements to BESS when it exports to the grid, but the applicable classification can depend on the country, operating mode, hybrid configuration, and connection arrangement. Confirm the route with the connecting TSO or DSO.

Why do Germany, Italy, and the Netherlands all have such large storage queues?

Developers in each market applied for far more grid capacity than the underlying network was planned to carry. Partly, that happened because reserving a queue position cost little relative to a project’s potential value. All three countries have since introduced readiness or maturity-based rules to filter for projects genuinely likely to proceed.

Can a battery help resolve grid congestion instead of just adding to it?

In some markets, yes. The Netherlands’ congestion-mitigator framework, for example, lets a battery accept flexible or conditional access in exchange for helping manage congestion at the network operator’s request. Similar flexible-connection concepts are emerging elsewhere in Europe too.

How long does a Europe BESS grid connection take?

It varies enormously by country and by position in the relevant queue or pipeline. A small distribution-connected project can sometimes progress in months. A large, transmission-connected project in a congested market can take years, particularly in markets still working through a legacy backlog.

Do I need compliance certification before energising?

In many European countries, yes, particularly for larger or higher-type projects. Requirements vary by country and by RfG type, so the specific certification and testing route is best set early, with the connecting network operator.

Glossary of Terms for This Europe BESS Grid Connection Guide

Because this guide spans several countries, here are the key terms and institutions, defined in plain terms.

EU-Level Terms and Institutions

RfG — Requirements for Generators — Regulation (EU) 2016/631, the EU network code establishing baseline requirements for connecting Power-Generating Modules. National frameworks may apply related requirements to battery storage depending on the project’s operating mode and connection arrangement.

ENTSO-E — European Network of Transmission System Operators for Electricity — coordinates technical implementation of RfG and related codes across national TSOs.

ACER — EU Agency for the Cooperation of Energy Regulators — recommends network codes and coordinates national energy regulators.

PGM — Power-Generating Module — a generating unit or group of generating units covered by the applicable connection requirements. Under RfG, PGMs are assigned Type A, B, C, or D requirements according to the applicable capacity, voltage, and national criteria.

Synchronous area — A group of interconnected power systems operating in synchronism at the same nominal frequency. RfG thresholds may differ by synchronous area.

National Institutions Referenced in This Guide

TSO — Transmission System Operator — the national (or, in Germany, regional) body that owns and operates the high-voltage transmission grid.

DSO — Distribution System Operator — the regional or local body that owns and operates the lower-voltage distribution network.

Bundesnetzagentur — Germany’s national energy regulator, which oversees grid connection rules and the country’s four TSOs.

CNMC — Spain’s national markets and competition regulator, which approves technical criteria for grid access alongside REE.

ARERA — Italy’s national regulator for energy, networks, and the environment, which sets connection rules through the TICA.

ACM — The Netherlands’ Authority for Consumers and Markets, which regulates grid congestion and connection-priority rules.

Important: This guide is general information, so treat it that way, not as legal, engineering, or connection advice. Grid-compliance requirements vary by country, network operator, project design, and the applicable rules at the time of assessment. Several of the markets covered here are actively reforming their connection processes. Confirm requirements with the relevant national TSO or DSO, national regulator, and qualified electrical, grid-connection, and legal advisers.

Further Reading on Europe BESS Grid Connection

More Sunlith Energy guides on battery storage connection, interconnection, and compliance.

Source

The EU-wide framework detail in this guide is grounded in the EU’s RfG regulation text.

SunLith Energy UK BESS grid connection map showing NESO, DNO and transmission network layers

UK BESS Grid Connection: G98, G99, NESO and Grid Code Guide

A UK BESS grid connection depends on the connection voltage, export capacity, site location, network operator, and the project’s status in the connections queue. Smaller distribution-connected systems commonly follow a DNO-led Engineering Recommendation G98 or G99 process. Larger embedded and transmission-connected projects, by contrast, may need more extensive system studies, Grid Code compliance, CUSC arrangements, and a place in the reformed connections process. So a battery is never approved just because its inverter rating matches the site.

Scope note: This guide covers BESS projects connecting in Great Britain (England, Scotland, and Wales), regulated by Ofgem and coordinated by NESO. Northern Ireland operates under a separate regulatory system, as part of the Single Electricity Market with Ireland, which this guide does not cover in detail.

Quick answer: A UK BESS grid connection depends on connection voltage, export capacity, location, and where the project sits in the connections queue. Smaller, distribution-connected batteries typically go through an Engineering Recommendation G98 or G99 application with the local DNO. Larger or transmission-connected projects usually need a Bilateral Connection Agreement, Grid Code compliance, and a place in NESO’s reformed connections pipeline.

So, this guide walks through:

  • How NESO, Ofgem, DNOs and Transmission Owners each fit into a BESS interconnection
  • The difference between distribution-connected (G98/G99/G100) and transmission-connected pathways
  • The stage-by-stage connection process, including NESO’s 2025 Connections Reform
  • Grid Code requirements for Electricity Storage Modules
  • UK-specific technical challenges and common project risks

UK BESS Connection Checklist

  • Identify the likely point of connection and confirm distribution versus transmission voltage.
  • Check whether the proposed installation falls within the applicable G98 current limit and notification conditions.
  • Confirm the project’s status and expected offer window under NESO’s Connections Reform pipeline.
  • Screen local network constraint and curtailment risk for the specific region.
  • Confirm the applicable Grid Code Power Generating Module Type and its technical requirements.
  • Ask the PCS supplier and system integrator for the model format the network operator requires, such as RMS or EMT, together with validated parameters, controller logic, and operating-mode assumptions, before finalising procurement.
  • Allow schedule contingency for studies, Bilateral Connection Agreement negotiation, and commissioning.

Who Governs a UK BESS Grid Connection?

SunLith Energy Diagram of NESO, Ofgem, Transmission Owner and DNO roles in a UK BESS grid connection

No single body runs UK BESS approval from start to finish. Instead, several organisations share the job, and the reformed connections process has changed how a few of them work together.

OrganisationMain role for BESS projects
NESOGreat Britain’s electricity system operator. Coordinates the reformed transmission-connection process and works with Transmission Owners and DNOs on queue reform and connection offers. For many distribution-connected projects, the relevant DNO remains the main counterparty, not NESO directly.
OfgemIndependent regulator for Great Britain. Approves code changes such as the Connections Reform modifications and regulates network company price controls.
Transmission OwnersBuild and maintain the transmission network. Examples include National Grid Electricity Transmission (England and Wales), SP Transmission and Scottish Hydro Electric Transmission (Scotland).
DNOs and iDNOsAssess and connect distribution-level projects. They process G98 and G99 applications, set local protection and export-limit conditions, and increasingly act as Distribution System Operators managing local network capacity.

So don’t assume NESO reviews every battery project directly, and don’t assume it runs a single unified pipeline on its own. Smaller, distribution-connected batteries mostly deal with their DNO, so keep that relationship central throughout.

Current detail on each body’s role: NESO, Ofgem.

Distribution vs. Transmission: Two Paths for a UK BESS Grid Connection

One factor shapes grid approval more than any other: where the asset physically connects, and at what voltage. Distribution and transmission pathways lead to very different applications and timelines.

FactorDistribution-connected BESSTransmission-connected BESS
Typical use caseC&I storage, community batteries, smaller grid-scale projectsUtility-scale storage, large co-located projects
Main counterpartyDNO or iDNONESO and the relevant Transmission Owner
Governing frameworkEREC G98, G99, and G100Grid Code, CUSC, and a Bilateral Connection Agreement
Technical focusExport limits, protection, voltage rise, anti-islandingPower Generating Module Type, dynamic performance, system studies
Key riskLocal network constraint, DNO queue positionConnections Reform pipeline position, study timelines

Project size alone doesn’t decide the pathway, though. A regional quirk matters here. In parts of Scotland, an embedded project as small as 30 MW can need a Bilateral Connection Agreement and CUSC party status. A similarly sized project in England or Wales, by contrast, may fall under the Licence Exempt Embedded Medium Power Stations arrangement instead. So confirm the specific threshold with the relevant network operator, rather than assuming a single GB-wide MW cut-off. More broadly, the categories in the table above are general planning distinctions, not universal legal classifications. A distribution-connected project can still carry Grid Code, CUSC, or transmission-system obligations depending on its configuration. So confirm the applicable route with the DNO, NESO, and the relevant Transmission Owner.

The UK BESS Grid Connection Process, Stage by Stage

SunLith Energy Six-stage flow diagram of the UK BESS grid connection process from screening to compliance

Treat the connection journey as a set of stages, not one checklist. Each stage builds on the last, and the 2025 Connections Reform changed how several of them work.

Stage 1: Site Screening and Capacity Assessment

First, check the site’s real limits before you lock in battery duration or PCS (power conversion system) rating. Review available capacity at the likely connection point. Then confirm whether the project falls within the applicable G98 current limit and notification conditions, or whether it will need a full G99 application instead. Next, assess local network constraint, since some regions are heavily congested for new BESS capacity, and a few areas have effectively closed for certain technologies.

Also map planning consent requirements and any land or grid-easement issues early. A connections queue position can take months to secure, so running planning and land work in parallel avoids a stacked delay later in the schedule.

Stage 2: Connection Application

Next, submit the applicable connection application. For distribution-connected projects, this usually means an EREC G99 application to the local DNO, identifying the proposed site, export capacity, inverter specifications, and intended operating modes. For larger or transmission-connected projects, this instead means an application to NESO. That application now sits inside the reformed Connections Reform pipeline, rather than the old first-come, first-served queue.

Stage 3: Studies and Queue Position

The network operator then sets the study scope for the project. Distribution-connected projects may need protection-coordination, voltage-rise, and export-limit studies. Larger or transmission-connected projects may also require load-flow, short-circuit, and dynamic-performance studies against the applicable Grid Code requirements.

Since 10 June 2025, eligible transmission-connected and some larger embedded projects are also assessed under NESO’s reformed connections framework, commonly known as TMO4+ (Target Model Option 4 Plus). Under this framework, a project earns a Gate 2 connection date and queue position by meeting defined readiness criteria and passing a strategic-alignment check. That replaces the old rule of holding a position by application date alone. Projects with existing agreements go through a one-off reassessment called Gate 2 to Whole Queue (G2TWQ). For small and medium embedded generators, NESO issues a Gate 1 offer to the DNO first, and the DNO takes it from there. The precise process depends on the project’s connection route, capacity, application status, and the relevant network operator. So confirm current requirements directly with NESO or the DNO, rather than assuming every project follows an identical path.

Stage 4: Connection Offer and Agreement

For distribution-connected projects, this stage produces the DNO’s response to a G98 or G99 application. Depending on the project and DNO process, that response may take the form of an acceptance, technical offer, connection offer, or approval subject to specific documentation. Either way, it sets out technical conditions and any required network reinforcement. For transmission-connected or larger embedded projects, this stage instead produces a Bilateral Connection Agreement. That agreement binds the project to the Connection and Use of System Code (CUSC) and the applicable Grid Code requirements. Offer timing now depends on the project’s phase and queue position under Connections Reform. So confirm current expectations directly with NESO or the relevant DNO, rather than relying on older published timelines.

Stage 5: Design, Construction and Commissioning

Commissioning confirms the installed plant matches the approved design. So, first, expect to provide as-built drawings and protection settings. Then witness testing and G99 or Grid Code compliance testing follow, covering protection, anti-islanding, and, where applicable, dynamic-performance verification. Commissioning evidence and updated models may also be required before the DNO or NESO issues final approval to energise.

Stage 6: Ongoing Compliance

Compliance does not stop once operation begins. Instead, changes to inverter firmware, protection settings, control-system configuration, or export limits may trigger a reassessment. So, treat compliance documentation as an ongoing operational task, not a one-off commissioning step, since it protects the connection agreement over the plant’s full operating life.

Realistic timelines vary widely by project size and location. A straightforward G98 or small G99 connection may progress in a matter of months. But a transmission-connected or large embedded project now depends heavily on its position in the reformed connections pipeline. NESO’s own December 2025 results show the queue moving in phases through 2026 and beyond. Build schedule contingency around queue position and study timelines, since both remain genuinely difficult to forecast precisely during this transition period.

Grid Code Requirements for a UK BESS Grid Connection

Grid Code requirements sit at the technical centre of any transmission-connected or large distribution-connected UK BESS grid connection. The Grid Code and associated connection-code provisions include requirements specifically relevant to Electricity Storage Modules. These interact with the applicable Power Generating Module classification, connection voltage, capacity, and operating mode.

First, the Grid Code sorts Power Generating Modules, including storage, into Types A to D. The thresholds are the same across Great Britain, and they set the technical requirements each module must meet. Then, depending on the module type and connection arrangement, a project may need to become a CUSC party. Or it may instead qualify for a licence-exempt arrangement handled mainly through the Distribution Code. Which pathway applies depends on connection voltage, project size, and sometimes regional variation. So confirm the applicable module type and compliance route directly with NESO or the relevant network operator early in development.

Performance areaWhy it matters for battery storage
Active-power controlThe BESS must charge, discharge, and respond to dispatch instructions accurately.
Reactive-power capabilityThe plant may need to inject or absorb reactive power to support voltage.
Frequency responseStorage can respond fast, but the response must still match the relevant Grid Code obligations.
Fault ride-throughThe plant may need to stay connected through defined voltage disturbances.
ProtectionSettings must clear internal faults while avoiding unnecessary tripping for external events.
Dynamic performanceValidated models help confirm the plant behaves as designed under real system conditions.

Background reading: NESO’s Guidance Notes for Electricity Storage EU Code Users.

Does Every BESS Need a Bilateral Connection Agreement?

No, not every project does. Whether a BESS needs a Bilateral Connection Agreement and CUSC party status instead depends on its connection voltage, capacity, and sometimes its specific region. The England/Wales-versus-Scotland threshold difference shows why. Smaller distribution-connected projects instead work through the relevant DNO under G98 or G99. Developers should confirm the applicable pathway during early site screening rather than rely on a single capacity threshold as a proxy.

G98, G99, and G100 for Distribution-Connected Batteries

For distribution-connected battery systems, Engineering Recommendations G98 and G99 are the core technical references, with G100 applying separately wherever export limitation is used. G98 covers connect-and-notify installations that meet specific current and equipment conditions, generally up to 16A per phase, roughly 3.68kW on a single-phase supply. Installations outside those conditions generally need a full G99 application, but the DNO should confirm the correct route for the proposed configuration rather than relying on capacity alone.

G100 applies where an export limitation scheme is used to restrict the power a site sends back to the distribution network. It is not specific to DC-coupled battery storage. A DC-coupled BESS may need to meet G98 or G99 requirements too, depending on the generating-unit and inverter configuration. And an export-limited connection normally needs a validated control scheme, metering arrangement, and fail-safe behaviour. The DNO needs to be able to rely on that behaviour if control, communications, or measurement fails. None of these Engineering Recommendations replace the DNO’s own connection agreement or local network conditions. Larger C&I or grid-scale battery projects should confirm export limits, protection requirements, and network reinforcement needs directly with the DNO. See our full BESS grid codes comparison for the country-by-country comparison, including how UK grid codes fit alongside other major markets.

Reference: ENA’s official G98/G99 forms and guidance.

Which UK BESS Connection Pathway Applies?

A quick self-check before diving into the detail below.

QuestionLikely implication
Is the system within the G98 current limit and notification conditions?G98 connect-and-notify may apply
Is the system above those G98 limits or conditions?A G99 assessment is likely
Does the project use an export limitation scheme?G100-related requirements may apply, alongside G98 or G99
Is the project transmission-connected or a large embedded project?NESO, the Transmission Owner, CUSC, Grid Code, and BCA requirements may arise
Is the project in the reformed connections queue?Gate 1 or Gate 2 status and readiness evidence may affect timing

Technical Challenges Unique to a UK BESS Grid Connection

A few UK-specific conditions make grid approval harder here than a generic global playbook suggests. These conditions shape both design choices and realistic project timelines.

Connections Reform and Queue Position

As Stage 3 covers, readiness now matters as much as application date. NESO’s own reporting shows the pre-reform queue exceeded 700 GW, while the reformed pipeline instead prioritises a smaller, more deliverable set of projects. In practice, that means a project’s land rights, planning progress, and evidence pack can matter more to its timing than how early it applied.

See: NESO’s Connections Reform results.

Grid-forming capability: NESO has published dedicated technical guidance for grid-forming plant, including Electricity Storage Modules. In some locations, connection studies may consider whether grid-forming controls can support network stability. Grid-forming capability is not a substitute for a connection assessment, however. Its value depends on the network need, the plant’s control design, and the operating characteristics the project accepts. So treat it as one design input among several, not a fix on its own.

See: NESO’s Grid Forming Guidance Note.

Regional Network Constraint

Network capacity for new BESS varies sharply by region. Some parts of Great Britain, including areas of Scotland, face significant constraint for new storage and generation capacity. So, in practice, a site’s regional location can matter as much as its technical design for realistic connection timing.

Curtailment and Commercial Risk

A connection offer may include a formal non-firm connection, active network management, or another constraint mechanism in congested areas. These are not all the same thing. Distribution export limitations, transmission constraint costs, and scheduled or dynamic curtailment can each apply differently depending on the connection. Because of this, test your revenue model against the specific curtailment terms in your own connection offer, not a generic assumption. Do this before you finalise the business case. A conservative revenue case, built around the connection offer’s real terms, protects the project from an optimistic forecast that never eventuates.

Common Risks in a UK BESS Grid Connection

Most delays in a UK BESS grid connection trace back to a small set of repeat mistakes. So here is how to catch them early.

RiskConsequenceMitigation
Assuming a single GB-wide MW threshold appliesWrong compliance pathway assumed earlyConfirm the applicable threshold with the specific network operator
Treating queue position as fixed by application dateSchedule built on outdated queue assumptionsTrack readiness and Gate 2 status directly through NESO
Selecting a site before checking regional constraintUnexpected non-firm terms or long delaysScreen regional network capacity early in site selection
Incomplete or unvalidated dynamic modelsDelayed studies and commissioning reworkRequire validated models from the PCS vendor and integrator
Treating Grid Code compliance as an afterthoughtDesign changes late in developmentConfirm the applicable Power Generating Module Type early
Uncontrolled post-commissioning changesNon-compliance or reassessment obligationsSet up formal change-control for firmware and protection settings

Planning a BESS project in the UK? Start with a connection-readiness assessment. Cover site capacity, regional constraint, the applicable Grid Code or G98/G99 pathway, and Connections Reform queue status, before you finalise equipment specifications.

Frequently Asked Questions About a UK BESS Grid Connection

Common questions developers ask before signing a connection agreement, answered directly.

Do I need G98 or G99 for a battery storage system?

It depends on the maximum design current per phase and the connection arrangement, not just battery nameplate capacity. Systems that meet the G98 current limit and notification conditions, generally up to 16A per phase (roughly 3.68kW single-phase), can usually connect-and-notify. Systems outside those conditions generally need a full G99 application instead. The assessment timescale varies by DNO and project complexity, so treat any indicative period as a planning estimate, not a guaranteed service window.

What is NESO’s Connections Reform and how does it affect BESS projects?

Connections Reform, approved by Ofgem on 15 April 2025 and live from 10 June 2025, replaced the old first-come, first-served queue with the readiness-based TMO4+ model. Eligible projects earn a Gate 2 connection date by meeting readiness criteria and passing a strategic-alignment check, rather than by application date alone. Projects with existing agreements go through a one-off reassessment called Gate 2 to Whole Queue. The precise process still varies by connection route and network operator.

Does every large BESS project need a Bilateral Connection Agreement?

Not automatically. As the regional-threshold note above explains, it depends on connection voltage, capacity, and sometimes region. Confirm the applicable pathway with the relevant network operator during early screening, rather than assuming a fixed MW cut-off.

What is G100 and when does it apply?

G100 applies where an export limitation scheme is used to restrict how much power a site sends back to the distribution network. It is not specific to DC-coupled battery storage; a DC-coupled BESS may still need G98 or G99 separately, depending on its configuration. Confirm the applicable route with the DNO.

Does Northern Ireland follow the same rules as Great Britain?

No. Northern Ireland operates under a separate regulatory system, as part of the Single Electricity Market with Ireland, with its own versions of the equivalent engineering recommendations. This guide focuses on Great Britain.

How long does a UK BESS grid connection take?

It varies widely. A straightforward G98 or small G99 connection can take months. A transmission-connected or large embedded project now depends heavily on its position in the reformed connections pipeline, which is still moving through its phased rollout.

What is system constraint and how does it affect BESS projects?

Network constraint describes limited capacity at a given location to accept new generation or storage. In constrained areas, a connection offer may come with curtailment terms or a non-firm connection, which developers should factor into their revenue modelling.

Can a battery connect without full export capability in the UK?

Yes, in some cases. A non-export or export-limited design under G100 can simplify the connection pathway, especially for smaller distribution-connected projects. However, the project generally still needs DNO approval. It also needs a validated control scheme, metering arrangement, and fail-safe behaviour the DNO can rely on if control, communications, or measurement fails.

Glossary of Terms for This UK BESS Grid Connection Guide

Because this guide leans technical, here are the acronyms used throughout, defined in plain terms.

Organisations, Codes, and Agreements

BESS — Battery Energy Storage System — the battery, inverter, and control equipment that stores and dispatches electricity.

NESO — National Energy System Operator — Great Britain’s independent electricity system operator, responsible for coordinating the reformed transmission connections process.

Ofgem — The independent regulator for Great Britain’s gas and electricity markets, which approves code changes such as the Connections Reform modifications.

DNO — Distribution Network Operator — the regional company that owns and operates the local electricity distribution network.

iDNO — Independent Distribution Network Operator — a licensed operator of a distribution network not owned by the regional DNO, often serving a specific site or development.

TO — Transmission Owner — the company that builds and maintains the transmission network in its region, such as National Grid Electricity Transmission or SP Transmission.

CUSC — Connection and Use of System Code — the industry code governing transmission connection and use-of-system arrangements in Great Britain.

BCA — Bilateral Connection Agreement — the formal agreement binding a transmission-connected or large embedded project to CUSC and Grid Code requirements.

PGM — Power Generating Module — the Grid Code classification (Types A to D) based on connection voltage and capacity, which sets a project’s technical requirements.

ESM — Electricity Storage Module — the Grid Code and connection-code term for a battery storage installation, which interacts with the applicable PGM classification.

Connection Types and Process Terms

G98 — The Engineering Recommendation for connect-and-notify generation and storage installations that meet specific current and equipment conditions.

G99 — The Engineering Recommendation requiring DNO approval before connection, for installations that fall outside G98 conditions.

G100 — The Engineering Recommendation covering export and import limitation schemes, applicable wherever a project limits what it sends to or draws from the network.

TMO4+ — Target Model Option 4 Plus — the readiness-based connections queue model introduced under the 2025 Connections Reform.

Gate 1 — An indicative connection offer stage, typically issued to the DNO for small and medium embedded generators under the reformed process.

Gate 2 — The stage at which a project earns a confirmed connection date, point of connection, and queue position, after meeting readiness and strategic-alignment criteria.

Important: This guide is general information, so treat it that way, not as legal, engineering, or connection advice. Grid-compliance requirements vary by network operator, project design, location, and the applicable rules at the time of assessment. The UK’s connections framework is also under active reform. Confirm requirements with the relevant DNO, NESO, Ofgem where applicable, and qualified electrical, grid-connection, and legal advisers.

Further Reading on UK BESS Grid Connection

More Sunlith Energy guides on battery storage connection, interconnection, and compliance.

Source

Grid Code and Connections Reform detail in this guide is grounded in NESO’s Connections Reform overview.
