A C&I BESS warranty is not just a number of years. It is a contract that guarantees performance only inside a defined operating envelope.
That envelope covers capacity, throughput, depth of discharge, C-rate, and temperature. However, operating outside a stated limit may reduce coverage or affect a claim, depending on the contract terms and the documented cause of the issue.
First, this guide shows how to read each term before you sign. It also ties the warranty back to your peak-shaving BESS sizing, so the system can still meet your kW and kWh needs late in life.
⚡ Quick Answer: A C&I BESS warranty is more than a number of years. It is a set of performance promises that apply only within defined operating limits. So check guaranteed capacity, throughput, depth of discharge, C-rate, temperature, test method, exclusions, and the remedy before you compare suppliers.
What a C&I BESS Warranty Actually Covers
A C&I BESS warranty usually bundles several separate promises. Scope, duration, and exclusions vary by supplier and contract, so read each promise on its own.
Product or defect warranty: covers faulty parts and manufacturing defects.
Capacity-retention warranty: guarantees a minimum state of health (SoH) at set points in time.
Throughput or cycle-life warranty: limits the total energy or cycles the system may process.
Performance warranty: may add an efficiency commitment, depending on the contract.
Workmanship warranty: covers installation quality when SunLith or an EPC provider supplies it.
Subsystem coverage: identifies whether the PCS, EMS, BMS, HVAC, enclosure systems, and any supplied fire-detection or suppression equipment are covered, and for how long.
Also, each item can carry its own term, limits, and remedy. For example, a long cell warranty does not prove the PCS or cooling system is covered for as long.
C&I BESS Warranty Terms: Capacity Retention vs. Throughput
Most disputes over a C&I BESS warranty start with two terms. But capacity retention and throughput control very different things.
Term
What it controls
Buyer question
Capacity retention / SoH
Remaining usable energy at a specified point in time
At what measurement boundary and operating conditions is capacity tested?
Throughput
Total permitted energy processed during the warranty
Is throughput counted one way, both ways, or as equivalent full cycles?
Equivalent full cycles
An accounting measure of throughput relative to capacity
What capacity denominator and counting method does the contract use?
End-of-life threshold
The contractual capacity floor at a stated year or throughput value
Does that floor still satisfy the project’s service obligation?
Capacity Retention and State of Health
Capacity retention sets the minimum usable energy at a stated point in time. For example, a contract might guarantee 70% of baseline capacity at year 10 (illustration only).
First, the key issue is the measurement boundary. Capacity can be quoted at the cell, the DC bus, the PCS AC output, or the point of interconnection.
Because of this, each boundary gives a different number. Also confirm the beginning-of-life baseline, because a retention percentage means little without it.
Throughput and Equivalent Full Cycles
A throughput provision may limit the cumulative energy processed during the warranty. For example, some contracts count discharge only, while others count charge and discharge together.
Then equivalent full cycles convert that energy into a cycle count. The result depends on the capacity used as the denominator, so ask for the exact formula.
An open-access review in Energies discusses degradation models based on cumulative energy throughput. It also covers models that account for cycling conditions such as depth of discharge, state of charge, and temperature.
But contracts often use the simpler count. Your dispatch pattern still decides how fast the cells age, so learn how equivalent full cycles and throughput records are tracked in the BMS.
End-of-Life Thresholds

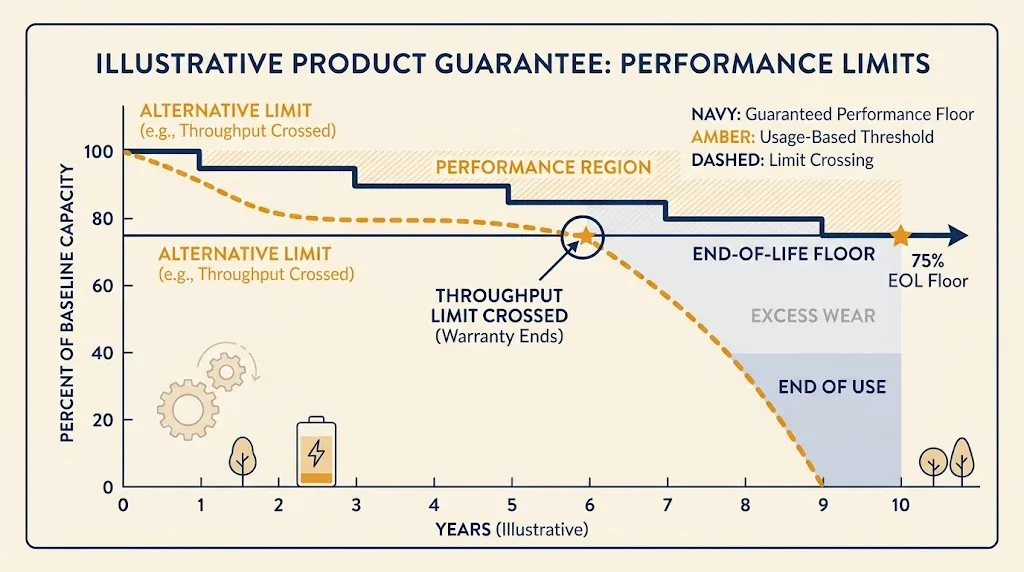

An end-of-life threshold is the contractual capacity floor a supplier agrees to support, subject to the stated terms. It applies at the year or throughput value that the contract names.
Then check that this floor still meets your service obligation. As a result, a battery can meet its warranty floor and still miss your load requirement.
Capacity fades on two clocks, time and use. See calendar and cycle aging for how each one works.

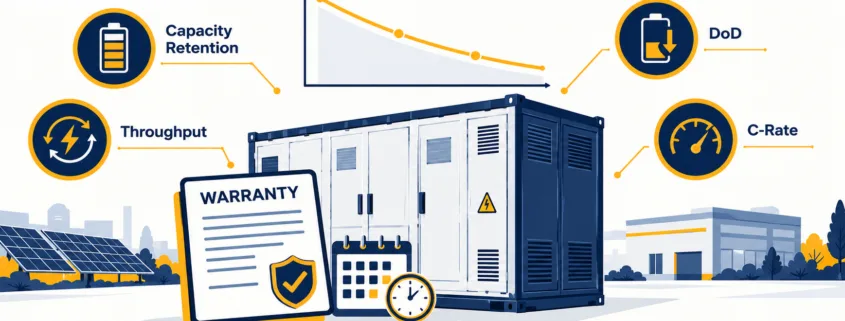

The Operating Envelope Behind Every C&I BESS Warranty
Every C&I BESS warranty rests on assumed operating conditions. As a result, if the site operates outside those conditions, coverage may be limited or a claim may be disputed under the contract.
A warranty can be technically valid but commercially unsuitable if the operating limits do not match the intended dispatch plan.
Charge, Discharge, and Depth Limits
First, list every electrical limit the contract sets. Typical items include:
Maximum and minimum state of charge
Permitted depth of discharge
Charge and discharge C-rate
Throughput terms often carry a maximum C-rate clause as well. Then compare your peak discharge power against the BESS C-rate limit in the contract.
Time, Temperature, and Throughput Limits
Next, check the limits tied to time and environment:
Temperature and humidity requirements
Calendar limits versus cycling limits
Annual or cumulative throughput limits
For example, many contracts specify that coverage ends when the first applicable limit is reached. So look for the phrase “whichever occurs first.”
Controls, Data, and Maintenance Duties
Finally, review what the owner must do to keep coverage intact:
Follow the approved EMS settings and dispatch behavior
Complete the required maintenance
Keep connectivity, monitoring, and event logging active
However, missing data can make a claim hard to win. Our guide to evaluating a supplier’s BMS also explains SOH and throughput logging.
Sizing sets your first kW and kWh requirement. The C&I BESS warranty then decides whether the system can keep meeting it.
Take the 100 kW / 278 kWh preliminary configuration in the peak-shaving guide. It illustrates how first-year power and energy requirements can be estimated for one defined peak event.
However, whether it can meet repeated events or retain enough capacity late in life depends on the operating plan and the warranty’s limits.
Next, here is a simple, hypothetical check. If a contract permits 3,000 equivalent full cycles, and the site uses one equivalent full cycle on each day it operates, daily cycling would reach that limit in about 8.2 years (3,000 ÷ 365).
But if the system uses one equivalent full cycle on only 150 days each year, it would take about 20 years to reach the same limit. Calendar limits may then determine when coverage ends.
Also, an equivalent full cycle is an energy measure, not a single dispatch event. These figures are illustrations, not market terms.
So check size and dispatch strategy against the warranted envelope, not just first-year savings. Warranty terms also feed your BESS OPEX and CAPEX vs LCOS assumptions, because lost throughput raises the cost of each delivered kWh.
C&I BESS Warranty Checklist for RFQs
First, use this C&I BESS warranty checklist in every request for quotation. Ask each supplier the same questions so the answers compare cleanly.
Capacity and Baseline Questions
Is capacity measured as nameplate, usable DC, PCS AC, or energy at the point of interconnection?
Which beginning-of-life capacity baseline applies?
How much retained capacity is guaranteed at each year or throughput checkpoint?
Which testing method verifies capacity, and under what site conditions?
Throughput and Operating Limit Questions
Is there a calendar limit, cycle limit, throughput limit, or a “whichever occurs first” condition?
How is throughput counted: charging, discharging, both directions, or equivalent full cycles?
What DoD, C-rate, temperature, SOC range, and dispatch pattern does the warranty assume?
How is an equivalent full cycle calculated and logged?
Scope, Exclusion, and Remedy Questions
Which components are included: cells, modules, racks, BMS, PCS, HVAC, EMS, enclosure systems, and any supplied fire-detection or suppression equipment?
Which exclusions can reduce or invalidate coverage?
What data must the owner retain to support a claim?
If the system misses a warranted value, what is the remedy: repair, replacement, payment, capacity augmentation, or another remedy? Who pays for labor, logistics, downtime, testing, and recommissioning?
Since the remedy may be added capacity, plan that work early. Our guide to BESS augmentation planning explains how lost capacity is restored.
Common Mistakes When Comparing Warranty Bids
Buyers often repeat the same errors when they compare bids. Next, avoid these five:
Comparing years alone: two bids with equal terms can carry very different limits.
Ignoring the measurement boundary: a DC figure and an AC figure are not the same promise.
Assuming equal throughput counting: one bid may count discharge only, another both directions.
Skipping the dispatch check: the warranty may not fit your real duty cycle.
Accepting a vague remedy: insist on clear timing, cost, and responsibility.
Frequently Asked Questions About a C&I BESS Warranty
These answers cover the questions buyers ask most about a C&I BESS warranty.
What does a C&I BESS warranty cover?
It usually covers defects, a capacity or state-of-health guarantee, and sometimes a throughput limit. Also, scope and duration vary by supplier and contract.
How do capacity retention and throughput differ?
Capacity retention sets a minimum usable energy at a point in time. Meanwhile, throughput caps the total energy the system may process during the warranty.
Can a C&I BESS warranty be valid but still unsuitable?
Yes, because if its limits on depth, C-rate, or throughput do not match your dispatch plan, the system can reach a contract limit early.
What is a BESS performance warranty?
A BESS performance warranty defines measurable commitments, such as usable capacity, capacity retention, energy throughput, availability, or efficiency, under specified test conditions and operating limits. The exact scope and remedy depend on the contract.
What is end of life in a BESS warranty?
It is the contractual capacity floor at a stated year or throughput value. Then confirm that it still covers your required kWh.
Who should review a BESS warranty before signing?
Your engineer, procurement lead, and legal counsel should each review it. SunLith can provide a preliminary specification review, but contract terms need qualified legal review.
Need a Preliminary Warranty Review?
Send us your datasheet and draft warranty terms. Then we will flag the limits that matter for your dispatch plan.
SunLith can provide a preliminary assessment. Final system design and contract terms require site-specific electrical, tariff, interconnection, safety, and legal review.
Further Reading on the C&I BESS Warranty and Related Costs
Also, use these guides alongside this C&I BESS warranty guide.
Peak shaving battery sizing starts with two questions. How much power must the battery discharge? For how long? First, choose the maximum grid demand you want your facility to draw. Then analyze your interval load data. The highest load above that target sets the discharge power, in kW. The area above the target sets the delivered energy, in kWh.
Quick Answer
Peak-shaving battery sizing starts by subtracting the selected grid-demand target from site load in each interval. The highest result is the preliminary battery discharge-power requirement in kW. Add the interval discharge energy to estimate delivered kWh, then adjust for defined discharge efficiency and permitted usable capacity.
Those two numbers are only a starting point, though. A workable design must also account for discharge losses and the battery’s allowed operating range. It also needs to handle repeated peaks, charging opportunities, and how your utility calculates billed demand. Peak shaving means discharging a battery to cut peak grid demand. That is different from shifting energy use to another time, or sizing a battery for outage backup.
The Peak Shaving Battery Sizing Formulas at a Glance
Peak shaving battery sizing follows four simple steps for each interval in your load data. Confirm the measurement boundary, such as battery DC terminals, PCS AC output, or site meter, before applying efficiency assumptions.
New to these units? SunLith’s Ah vs Wh battery capacity guide covers the Wh = Ah × voltage relationship behind every kWh figure below.
Key Sizing Formulas
First, find the battery discharge required, in kW. Take site load, subtract the grid-demand target, and floor the result at zero. A 700 kW load against a 600 kW target needs 100 kW of discharge. A 550 kW load against the same target needs none.
Pbattery,i = max(0, Li − T)
Next, find the largest required discharge across every interval. That becomes your preliminary AC discharge-power requirement.
Prequired = maxi(Pbattery,i)
Then find the delivered energy, in kWh. Add up, across every interval in one peak event, the discharge required multiplied by the interval length in hours.
Edelivered = Σi(Pbattery,i × Δti)
Finally, estimate nominal battery capacity. Divide delivered energy by discharge efficiency, then by the usable fraction of nominal capacity. Discharge efficiency is the assumed efficiency from the battery’s energy boundary to the AC delivery point. The usable fraction is the share of nominal capacity available for this duty. Define both terms before you apply the formula, since this is only an event-level estimate. It is not a substitute for simulating state of charge over time.
Enominal = Edelivered ÷
(ηdischarge × fusable)
Where: Pbattery,i is the required battery discharge during interval i;
Li is site load; T is the selected grid-demand target;
Δti is interval duration in hours;
ηdischarge is defined one-way discharge-path efficiency; and
fusable is the permitted usable share of nominal capacity.
Step 1: Gather Load Data and the Tariff
First, ask your utility or metering provider for interval demand data covering representative operations and seasons. You need to see the shape of each peak, not just the highest number on a bill. A 100 kW exceedance lasting 15 minutes requires far less delivered energy than the same exceedance lasting three hours.
Also collect the tariff alongside the data. Identify the demand-measurement interval. Check which periods carry demand charges. Look for other billing provisions that affect the value of reducing a peak. The target should be based on how demand is measured and billed under the applicable tariff, not a generic assumption about demand charges.
One MDPI-published study of low-voltage commercial users evaluated battery energy capacity against measured customer-load data and the resulting peak reduction over time. The principle for a single facility is the same: use interval data rather than a monthly peak alone.
If the site has solar, use net demand at the relevant meter. Also model how solar output varies during likely peak events. A sunny-day profile alone may understate the battery needed on a cloudy day.
Step 2: Choose a Grid-Demand Target
Suppose a facility’s load sometimes reaches 700 kW. You could test targets of 650 kW, 600 kW, and 550 kW. Generally, a lower target asks the battery to provide more power, more energy, or both. However, whether that extra capacity pays off depends on the tariff and the full pattern of peaks.
Do not pick the target from the single highest reading alone. A battery might shave the largest peak successfully. Then it may exhaust its usable energy during a longer, lower peak later that day.
Step 3: Calculate Required Battery Power
For each interval, subtract the target from site load. If the result is negative, set the discharge requirement to zero. The table below shows this for a 600 kW target.
Example: discharge needed to hold a 600 kW target
Site load
Discharge needed to hold 600 kW
550 kW
0 kW
650 kW
50 kW
700 kW
100 kW
The preliminary requirement here is 100 kW of AC discharge power, measured at the point where the battery offsets meter demand. An engineer must then confirm that the chosen power conversion system and installation can sustain that output under real operating conditions.
Step 4: Calculate the Delivered Energy for Each Peak
Power tells you how fast the battery must discharge, while energy tells you how much it must deliver over the whole event.
For preliminary analysis, define a peak event as consecutive metering intervals where site demand stays above the selected grid-demand target. If demand drops below the target and the battery can begin recharging, treat the next exceedance as a separate event. Verify that the available recharge time and charging-power limit are sufficient.
Assume the facility stays at 700 kW for one hour. Then it drops to 650 kW for two hours, still against a 600 kW target. That gives 100 kW for one hour, plus 50 kW for two hours. The total is 200 kWh delivered.
So this event requires 100 kW of maximum discharge and 200 kWh of delivered AC energy. A battery rated for 100 kW but able to deliver only 100 kWh would not cover the whole event at this target.
Repeat this calculation for other days and seasons. The event with the highest instantaneous discharge sets one constraint. The event with the greatest delivered energy may set the energy-capacity requirement.
Step 5: Estimate Nominal Battery Capacity
The battery must store more energy than it ultimately delivers. Discharge is not lossless, and the full nominal capacity may not be available for the chosen operating strategy.
For illustration, assume 200 kWh of required delivered energy. Assume a 90% one-way discharge-path efficiency and an 80% permitted usable fraction of nominal capacity. Divide 200 by 0.90, then by 0.80. That gives roughly 278 kWh of nominal capacity.
That figure is only an initial estimate, not a recommended product size. First, check the vendor’s capacity definition. Then account for state-of-charge limits, expected end-of-life capacity, temperature effects, auxiliary consumption, warranty commitments, and the manufacturer’s defined AC or DC capacity boundary before choosing a product.
Accounting for Discharge Losses vs. Round-Trip Efficiency
Do not treat round-trip efficiency as one-way discharge efficiency. Round-trip efficiency includes losses across both charging and discharging. Applying it as a discharge factor, then adding separate discharge losses on top, counts losses twice. A preliminary sizing tool may use round-trip efficiency as a simplified assumption. Final peak shaving battery sizing should still call out discharge-path losses on their own.
SunLith’s guide to understanding BESS specifications explains how vendors actually define usable capacity and efficiency, both needed for this step.
Step 6: Test Repeated Peaks and Recharging
The example above assumes the battery has enough charge when the event begins. Real facilities may see several peaks a day, peaks on consecutive days, or an unusually long stretch above the target. Charging too aggressively can itself create a new metered peak.
Run the load profile forward, interval by interval, using these five steps.
Begin with an assumed battery state of charge.
Discharge whenever load would otherwise exceed the chosen target.
Track remaining energy and all applicable losses.
Allow charging only when it fits the tariff, site load, and equipment limits.
Check whether the battery is ready for the next event.
This simulation may reveal that a seemingly adequate 100 kW / 278 kWh preliminary configuration needs more capacity. Or it may show that a different demand target produces a better project. Model peak-shaving dispatch and resulting bill impacts together this way, instead of inferring them from a single peak value.
Sample Interval-Data Worksheet Columns
A simple spreadsheet makes this simulation easier to run and easier to hand to an engineer. Track these six columns for every interval in the load dataset.
Column
What it records
Timestamp
Date and interval start time
Site load (kW)
Measured or forecast demand for the interval
Target (kW)
The grid-demand target being tested
Discharge required (kW)
Site load minus target, floored at zero
Delivered energy (kWh)
Discharge required times interval hours
Simulated state of charge (%)
Running battery charge after each interval
Step 7: Check Whether the Battery Size Makes Financial Sense
A technically workable target is not always the most economical one, though. Compare several combinations of battery power, energy, and target demand against the real tariff and a no-storage baseline. Include the cost of charging, equipment and installation, operating costs, and expected capacity changes over the project life.
SunLith’s peak shaving vs load shifting guide explains the two strategies and where they overlap. Use it to understand the value stream, not as an interval-based sizing tool.
For the financial modeling itself, SunLith’s guide to calculating BESS ROI walks through the cash-flow side. Use it once the power and energy numbers from this sizing exercise are in hand.
Common Peak Shaving Battery Sizing Mistakes
Because these errors repeat across projects, they turn a sound peak shaving battery sizing exercise into an undersized or overpriced one.
Using only the monthly peak: It does not show how long or how often demand exceeds your target.
Confusing kW with kWh: The maximum exceedance sets discharge power. Duration and shape set delivered energy.
Sizing from one favorable day: Solar production, weather, occupancy, and operations can all change the peak profile.
Ignoring the next event: The battery may suit one peak but fail to recharge before another.
Assuming every kWh of nameplate capacity is usable: Operating limits and performance requirements must be checked against the proposed product.
Treating demand-charge savings as guaranteed: Actual savings depend on successful dispatch and the applicable tariff.
Frequently Asked Questions About Peak Shaving Battery Sizing
These questions come up often once a facility starts peak shaving battery sizing from its own interval data.
Can I size a peak shaving battery from a utility bill?
A bill shows billed demand and charges, but it usually will not show the full duration and shape of the peaks. First, use interval data for a credible power-and-energy estimate. Then apply the tariff to evaluate savings.
Is a 100 kW battery enough to reduce my peak by 100 kW?
Not necessarily. First, it must deliver that power at the relevant point in the electrical system. Also, it needs enough energy and state of charge for the whole event. Finally, it must stay available for other peaks that affect the bill.
How many hours of battery storage do I need for peak shaving?
There is no universal duration. First, calculate the energy above your chosen demand target across actual events. Then test whether the proposed power and energy ratings can meet those events repeatedly.
Is peak shaving battery sizing the same as backup sizing?
No. Peak shaving battery sizing follows measured site demand above a grid-import target. Backup sizing starts instead with the critical loads that must run during an outage, and the required backup duration. It is a different starting point and a different formula set. For preliminary outage-backup estimates, use SunLith’s C&I BESS sizing calculator. It uses critical-load and backup-duration inputs, so it should not be used to size a peak-shaving system.
This article gives a preliminary sizing method, not an equipment specification or a savings guarantee. Final selection still needs interval-data and tariff analysis, electrical design, and product-specific validation.
Need a Peak-Shaving BESS Assessment?
A preliminary battery size should be tested against your actual interval demand data, tariff rules, charging windows, and operating priorities. Send SunLith your site load profile and utility tariff for an initial C&I BESS assessment.
Quick answer Diesel generator replacement with BESS works in three steps. First, convert your generator’s kVA rating to real kW using the power factor. Second, size the battery in kWh to your load and backup hours. Third, size the PCS in kW to your peak power, with a margin for inrush. A well-sized system cuts daily fuel cost. It switches in under 20 milliseconds, not 10-30 seconds. Most projects pay back in 4 to 7 years.
For most commercial and industrial (C&I) sites, diesel generator replacement is not a fringe idea anymore. So it is now a normal line item in capital planning.
Diesel gensets are reliable. But they cost money every hour they run, and they need constant upkeep.
A BESS closes that gap in three ways. First, it starts delivering power in milliseconds. Second, it has no moving parts to wear out. Third, when paired with solar, it can cut fuel use close to zero.
This guide covers the real costs, the sizing math, and the kVA-to-kW conversion your generator needs. Also, it covers PCS choice, four case studies, and a free sizing calculator you can add to this post.
Why Facilities Are Pursuing Diesel Generator Replacement in 2026
Three main pressures are pushing facilities away from diesel power. First, fuel prices remain high and unpredictable. Second, engines with hundreds of moving mechanical parts require constant upkeep. Third, ESG regulations are becoming increasingly strict.
While none of these factors are entirely new, LFP battery costs have dropped significantly in recent years. Consequently, the financial math for generator replacement now works for far more commercial and industrial sites than ever before.
The True Cost of Diesel Generator Replacement
Fuel is the biggest cost of running a generator. Also, it scales with load. For example, a diesel generator burns about 0.07 to 0.08 gallons per kWh at 70-80% load.
A 100 kW generator at 75% load burns about $402 a day in fuel alone. That is about $0.22 per kWh. Also, this does not include oil, filters, or testing costs.
Costs climb even more at partial load. In fact, generators run least efficiently below 40% load. That is where most backup units sit most of the time.
Maintenance and Wet-Stacking Problems
Because generators are complex mechanical systems, internal parts like pistons and valves naturally wear down over time. Therefore, they demand regular, costly service intervals.
Additionally, running generators at light loads leads to wet-stacking, which occurs when unburned fuel accumulates inside the exhaust system. As a result, the engine suffers accelerated wear and requires even more maintenance.
In contrast, a BESS has no moving mechanical components; consequently, it requires almost no scheduled maintenance beyond routine inspection checks.
Emissions and ESG Pressure
Because diesel exhaust releases high amounts of NOx, particulate soot, and $\text{CO}_2$, these emissions increasingly trigger warnings on environmental audits and insurance reviews.
However, a BESS creates zero on-site emissions during operation. Furthermore, when paired with a local solar array, overall facility emissions fall close to zero.
Generator kVA, BESS kWh, and PCS kW: Why the Units Are Different
Here is a detail that trips up many buyers. Generators are rated in kVA, not kW. That is apparent power, not real power.
BESS energy is rated in kWh. Also, PCS power is rated in kW. So these three units are not the same.
Mixing them up can badly oversize, or worse, undersize your system. So convert your generator’s rating to real kW first.
Converting Generator kVA to kW
kVA to kW Conversion Formula kW = kVA × Power Factor (PF) Industrial loads typically use a default PF of 0.8 unless your generator nameplate or a recent load study states otherwise.
For example, a 125 kVA generator running at a 0.8 power factor delivers 100 kW of real output (125 x 0.8 = 100 kW). Similarly, a 500 kVA generator at 0.85 power factor yields 425 kW of real power.
Therefore, you must always verify the actual power factor on your generator’s data sheet before sizing your battery system. Otherwise, a single inaccurate assumption will skew all subsequent calculations
Why BESS Uses kWh and PCS Uses kW
A BESS is sized in two distinct steps. First, energy capacity is measured in kWh to determine duration. Second, inverter capacity is measured in kW to handle the load.
Because energy sets runtime while power determines peak instantaneous capacity, confusing these two units often leads to costly site undersizing.
The table below keeps the three units straight.
Component
Unit
What It Measures
Diesel generator
kVA (apparent power)
Nameplate rating before power factor is applied
Real generator output
kW (real power)
kVA x power factor, the number you actually size around
BESS battery
kWh (energy)
How much energy is stored, and how long it can run the load
PCS / inverter
kW (power)
How much power it can deliver at any single instant
Cost Comparison: Diesel Generator Replacement vs. Keeping Your Genset
The table below compares the two options side by side.
Factor
Diesel Generator
BESS
Switching time
10-30 seconds (ATS transfer delay)
Under 20 milliseconds
Running cost
$0.22-0.28/kWh fuel at optimal load; $0.35-0.65/kWh all-in
No fuel cost; O&M is largely software-managed
Maintenance
Oil, filters, load-bank testing, overhauls
Minimal, no moving parts
Emissions
NOx, particulates, CO2 on every run
Zero on-site emissions
Fuel logistics
Needs on-site storage and refueling
None
Noise
65-85 dBA typical
Near-silent
Typical payback
Not applicable, an ongoing operating cost
4-7 years via avoided fuel and demand charges
Most sites do not remove the generator on day one. Instead, they install the BESS first, right alongside the running genset.
Next, the team tests switching performance on-site. Only then does the generator get downgraded to backup, or retired.
How to Size a BESS for Diesel Generator Replacement
Sizing a BESS depends on two primary metrics: energy (kWh) and power (kW). If you balance this ratio correctly, the system operates seamlessly.
However, if you miscalculate, the battery will either trip under heavy loads or unnecessarily inflate project costs.
Step 1 — Determine Your Critical Load in kW
Pull 12 months of interval data. Or, run a load study during a real outage.
If you only have kVA, convert it to kW first, using the formula above. Then use the load you actually want to keep on.
Full production and critical-circuits-only are very different numbers. So pick the right one upfront.
Step 2 — Determine Required Backup Hours
Base this on real outage history, not a guess. Instead, pull it from utility data or your own outage log.
Weak grids with short, frequent outages need a shorter, high-cycling BESS. Grids with rare but long outages, by contrast, need more stored energy per kW.
Step 3 — Calculate Nameplate Capacity for Diesel Generator Replacement
The baseline formula is shown below.
BESS sizing formula Usable Energy Required (kWh) = Critical Load (kW) x Backup Duration (hours) Nameplate Capacity (kWh) = Usable Energy Required x 1.2 safety margin / (Depth of Discharge x Round-Trip Efficiency) For LFP at 90% DoD and about 93% round-trip efficiency, this simplifies to: Nameplate Capacity (kWh) = Critical Load (kW) x Backup Duration (hours) x 1.43
The 1.2x margin covers load growth and inrush. The DoD and efficiency terms cover two more losses.
First, the energy a lithium battery cannot safely use. Second, conversion losses across the inverter and BMS.
Step 4 — Worked Examples
Here are three quick examples. Each one starts from a real kW figure, already converted from kVA.
50 kW load, 4-hour backup target: 50 x 4 x 1.43 ≈ 286 kWh nameplate capacity
100 kW load, 8-hour backup target: 100 x 8 x 1.43 ≈ 1,147 kWh, about 1.15 MWh
250 kW load, 2-hour bridge-power target: 250 x 2 x 1.43 ≈ 717 kWh
BESS Sizing Reference Table for Diesel Generator Replacement
Use this table for early budget sizing. Always confirm with a real load study first.
Critical Load
2-Hour Backup
4-Hour Backup
8-Hour Backup
25 kW
72 kWh
143 kWh
287 kWh
50 kW
143 kWh
287 kWh
574 kWh
100 kW
287 kWh
574 kWh
1,147 kWh
250 kW
717 kWh
1,434 kWh
2,868 kWh
500 kW
1,434 kWh
2,868 kWh
5,736 kWh
PCS and Inverter Sizing for Diesel Generator Replacement
Battery kWh and PCS kW get sized separately. Mixing them up is a costly mistake in BESS procurement.
As Sunlith’s BESS C-rate guide explains, size the PCS first, to the peak power you need. Then size the battery for the required duration.
Otherwise, a big battery behind a small PCS still cannot deliver full power. So the PCS becomes the real bottleneck, no matter how much energy sits in the racks.
PCS Power Rating: Add an Inrush Margin
Motors, compressors, and heavy HVAC units draw large surge currents during startup. Therefore, a standard sizing protocol adds a 1.25x margin over steady-state peak load.
However, for facilities operating heavy direct-on-line (DOL) motors, initial surge spikes can briefly reach 3x to 6x running current. As a result, you should round your final power rating up to the next standard PCS capacity tier.
Then round this up to the next standard PCS size. Most PCS units come in 50-500 kW steps.
Critical Load
PCS Rating (1.25x margin)
Approx. C-Rate at Rated kWh
50 kW
75 kW
0.26C, matches 4-hr duration
100 kW
125 kW
0.11C, matches 8-hr duration
250 kW
350 kW
0.49C, matches 2-hr duration
C-Rate and Discharge Duration
C-rate compares PCS power to battery energy. A 0.5C system runs at full power for 2 hours.
A 1C system, by contrast, runs for 1 hour instead. It also costs 20-40% more, since it needs bigger power electronics.
Past about 1.5C, systems often need liquid cooling too. Most 2-8 hour backup projects land in the 0.1C-0.5C range, which keeps cost down and favors longer cycle life.
Grid-Forming vs. Grid-Following PCS
A grid-following PCS needs a live voltage signal to sync to. It works for peak shaving, but not for a dead, powered-down site.
So true backup duty needs a grid-forming PCS, or a hybrid inverter with black-start. It must set voltage and frequency itself, the instant power drops.
Diesel Generator Replacement Sizing Calculator
Use the free calculator below to size your site. Enter your generator’s kVA, power factor, and backup hours.
It converts kVA to real kW, then applies the formulas from this guide.
Diesel generator replacement calculator
Enter your generator’s rating and backup needs to get a starting BESS and PCS/inverter size. This is a budgetary estimate — confirm with a load study before procurement.
Advanced settings (DoD, efficiency, margins)
Real load
— kW
Suggested BESS capacity
— kWh
Suggested PCS / inverter
— kW
Approx. C-rate
— C
How the Calculator Works
To operate the calculator, simply enter your generator kVA, power factor, optional kW override, and required backup duration.
Additionally, advanced settings allow you to fine-tune depth of discharge, system efficiency, and safety margins.
First, your real load in kW. Second, a suggested BESS size in kWh. Third, a PCS size in kW, rounded to a standard size. Finally, the resulting C-rate.
Input
Default
Purpose
Generator kVA
None, required unless using peak load override
Nameplate rating from the generator’s data plate
Power factor
0.8
Converts kVA to real kW
Peak load override (kW)
Blank
Use if you already have a measured kW figure
Backup hours needed
None, required
Sets the energy duration target
Depth of discharge
90%
Usable portion of the battery’s rated capacity
Round-trip efficiency
93%
Accounts for conversion losses
Energy safety margin
20%
Buffer for load growth and inrush
PCS inrush margin
25%
Buffer for motor and HVAC startup surge
Case Studies: Diesel Generator Replacement with BESS in Practice
The examples below come from real 2026 deployments.
Case 1 — Diesel Generator Replacement at an Industrial Plant
An Indian market study covered a plant that kept its diesel generator. Instead, it added a behind-the-meter BESS rather than removing the genset.
So the battery handled daily outages with frequent cycling. The generator, meanwhile, stayed on standby for deeper outages.
A 1-hour BESS, sized to the average outage, paid back faster than a bigger system built for worst-case events. That is a lesson against over-sizing.
Case 2 — Solar + BESS Replacing Diesel at High Altitude (Leh, India)
Leh is a remote, high-altitude region of India. But it has long relied on diesel for backup power.
There, solar-plus-storage was rolled out to replace diesel at scale. The same study found this works even off-grid, once local power prices rise even a little.
This matches the pattern in Sunlith’s Island Grid BESS engineering guide. There, solar takes over as the main power source, and the BESS covers stability and overnight load.
Case 3 — Diesel Generator Replacement for a Telecom Tower Network
A telecom operator ran diesel gensets across remote towers. As a result, this meant high fuel bills and constant upkeep.
So the company switched to solar-plus-battery as the main power source at each site. Generators stayed on as backup only.
Fuel use dropped a lot. As a result, generator runtime fell, service intervals stretched out, and uptime improved.
Case 4 — Hospital Hybrid Backup (Australia)
A hospital in Australia added a BESS next to its diesel generators. Instead, it did not remove them.
This fits any site where power loss is a safety risk. The hybrid setup cut daily fuel use and backed up short outages without starting the genset.
How to Transition from Generator to BESS: A Phased Approach
Audit the load: capture 12 months of interval data, or a representative outage load profile. Also, confirm whether backup covers full production or critical circuits only.
Size the BESS and PCS independently: use the kWh formula for energy. Then size the PCS to peak kW, with an inrush margin.
Install alongside the existing generator: commission the BESS in parallel, and do not decommission the genset until performance is proven.
Run site acceptance testing: verify switching time, SLA compliance, and grid-forming black-start behavior under real load.
Reclassify or retire the generator: once the BESS reliably carries day-to-day backup, shift it to a rarely-used secondary role. Or remove it from service entirely.
Key Takeaways on Diesel Generator Replacement
Point
Why It Matters
Convert kVA to kW before sizing anything
Generators are rated in kVA; BESS kWh and PCS kW both depend on the real kW figure
Size energy (kWh) and power (kW) separately
An undersized PCS behind a large battery still fails to carry the load
Use Load x Hours x 1.43 as a starting formula
Bakes in a 1.2x safety margin, 90% DoD, and about 93% round-trip efficiency for LFP
Diesel costs $0.22-0.65/kWh all-in
Fuel alone runs $0.22-0.28/kWh at optimal load; maintenance pushes it higher
Grid-forming PCS is required for true backup duty
Grid-following inverters cannot black-start a de-energized site
Install BESS alongside the generator first
Every documented case study kept the genset as backup during commissioning
Typical payback is 4-7 years
Driven by avoided fuel spend, plus demand charge and peak-shaving revenue
Frequently Asked Questions
Can a BESS completely replace a diesel generator?
Yes, for many sites. If outages run from minutes to a few hours, a well-sized BESS can fully replace the generator. It just needs a grid-forming PCS.
This also works if solar recharges the battery each day. But sites with life-safety loads, or rare, multi-day outages, often keep a generator as backup.
What is a realistic payback period for diesel generator replacement with BESS?
Most C&I projects pay back in 4 to 7 years. So this comes mainly from avoided fuel and upkeep cost.
It also comes from peak-shaving and demand-charge savings, on normal days with no outage.
Why does PCS sizing matter separately from battery kWh?
Battery kWh sets how long the system runs. PCS kW, by contrast, sets how much power it can push at once.
So an undersized PCS caps output, no matter how much energy sits in the battery.
How do I convert my generator’s kVA rating for BESS sizing?
Multiply the kVA rating by the power factor to get real kW. Most industrial sites run near 0.8 PF.
But check your generator’s data sheet to confirm. For example, 125 kVA at 0.8 PF equals 100 kW.
What battery chemistry works best for diesel generator replacement?
LFP is the standard choice for C&I diesel generator replacement. Also, it offers strong thermal stability and long cycle life.
It also carries no thermal runaway risk, unlike some other lithium types. This is the same reasoning behind Sunlith’s chemistry choice across its C&I line.
Quick Answer AI data centers strain power grids in two ways. First, they need massive amounts of power. Second, that power swings wildly, second to second. In practice, training a large GPU cluster can shift facility power by tens or hundreds of megawatts within milliseconds. AI data center BESS, battery storage deployed on-site, solves both problems. It absorbs these swings, bridges long grid connection delays, and cuts peak demand charges. As a result, it often costs far less than building new on-site generation.
1. The Power Problem Driving AI Data Center BESS
AI data center BESS has moved from a niche add-on to a core design requirement. Specifically, global data center electricity demand is set to top 1,000 TWh in 2026. That is roughly double the 2023 level. In the United States, data center power demand should climb by 400 TWh by 2030. That works out to about 23% growth each year. In fact, AI workloads alone could drive 30% to 40% of that new demand.
This growth has outpaced what utilities can build. Hyperscalers now sign gigawatt-scale power deals faster than new transmission lines can go up. As a result, a widening gap has formed. AI facilities need power on day one, but the grid often cannot deliver it on schedule. That is why AI data center BESS increasingly closes the gap, both on-site and in front of the meter.
2. Why Volatility Matters More Than Total Power
#image_title
Consequently, most conversations about AI data centers focus on total megawatts. However, the harder problem is how unevenly that power arrives. For example, a traditional data center runs thousands of small, unrelated tasks. Therefore, those tasks average out into a fairly flat load. In contrast, an AI training cluster works quite differently. Specifically, tens of thousands of GPUs execute in lockstep. As a result, they synchronize computation and communication in cycles that last just milliseconds.
A large training job often pauses for a checkpoint or a data-sync step. When it does, GPU power can fall from full load to near idle in a split second. Then it snaps back just as fast. At scale, these swings can move tens or even hundreds of megawatts almost instantly. For example, Meta’s own engineers have described this exact problem on a 24,000-GPU cluster pulling roughly 30 MW. Notably, they say the problem only grows as clusters get bigger.
According to Uptime Institute, these swings can push AI compute clusters to about 150% of their normal power draw. That strains transformers, UPS units, and protection gear never built for this kind of stress. Left unmanaged, the swings can trip upstream protection or shake grid equipment through resonance. In response, fast-responding battery storage can absorb or release power within milliseconds. So, AI data center BESS is one of the few tools that can smooth these swings before they reach the utility line.
3. Interconnection Queues Are the Real Bottleneck
Even a fully funded data center still has to wait in line to connect to the grid. As of late 2025, about 2,600 GW of generation and storage capacity sat in U.S. interconnection queues. Today, the median project takes close to five years to reach commercial operation. Some PJM-area projects have waited more than eight. Meanwhile, ERCOT alone had 143.5 GW of data center load seeking connection as of October 2025. That is well above the grid operator’s all-time peak demand of 85.9 GW.
In short, only a small share of queued capacity ever gets built. In fact, Lawrence Berkeley National Laboratory found that just 13% of capacity that applied for interconnection between 2000 and 2019 had reached commercial operation by the end of 2024. For a developer who needs power within 18 to 24 months, a five-to-eight-year queue is not a delay. It is a dealbreaker. Because of this, an estimated 50 GW of behind-the-meter data center power capacity was announced in 2025 alone. Most of it pairs on-site generation with co-located battery storage. This is exactly the gap AI data center BESS is built to bridge, until the grid connection is ready.
4. Where AI Data Center BESS Fits: Four Key Roles
AI data center BESS is not a single application. Instead, it covers four distinct jobs. Often, all four stack on the same battery asset.
Sub-Second Power Smoothing
Specifically, rack-level and facility-level battery banks can absorb a sudden GPU load drop. Then they discharge just as fast when demand snaps back. This turns a millisecond-scale spike into a gradual ramp. As a result, grid equipment and on-site generators can actually keep up. Chipmakers now pair this storage with power capping and staged ramp-up controls. Together, these keep facility-wide swings within a range utilities can tolerate.
Bridge Power for AI Data Center BESS
A co-located BESS can start covering peak loads the day a facility opens. This happens long before a full grid connection is approved. So, it buys time for transmission upgrades to catch up. The project does not have to sit idle for years waiting on first power.
Peak Shaving and Demand Charge Management
Typically, utilities bill large loads heavily for their single highest demand spike each month. By charging the battery during cheap, low-demand hours and discharging during peak windows, a facility can shave that spike. This can meaningfully cut a facility’s monthly bill. For more detail, see Sunlith’s guide to peak shaving and demand charge reduction.
Grid Services and Energy Arbitrage
Additionally, a stand-alone BESS in front of the meter can also earn revenue on its own. It charges when wholesale prices are low. Then it discharges, or provides frequency regulation, when prices spike. In turn, this transforms backup infrastructure into a second income stream, not just a cost center.
5. BESS vs. Alternative Power Strategies for AI Facilities
Data center developers rarely choose one power strategy alone. Instead, the table below compares how AI data center BESS stacks up against other tools developers are using in 2026.
Strategy
Response Time
Deployment Timeline
Best For
BESS
Milliseconds to seconds
6–18 months
Power smoothing, peak shaving, bridge power
On-site gas generation
Seconds to minutes
12–24 months
Sustained bridge power at large scale
Grid-forming UPS / capacitor banks
Microseconds
Built into facility design
Ride-through for the shortest transients
Small modular reactors (SMRs)
Not applicable (baseload)
5+ years
Long-term, always-on capacity
6. Sizing AI Data Center BESS: What to Consider
Not every BESS deployment looks the same. Sizing one for an AI data center starts from a different set of questions than a typical grid-scale project.
Response Time and C-Rate
Smoothing millisecond-scale GPU swings needs a battery and inverter rated for very fast response. This matters more than raw capacity. It is a different design target than a system built purely for hours-long peak shaving.
Duration: Burst Smoothing vs. Bridge Power
A system built to absorb short, sharp swings needs little energy capacity but very high power. By contrast, a system meant to bridge months or years of interconnection delay needs the opposite. It needs sustained duration to cover real load, not just brief spikes.
AI Data Center BESS Placement: Rack vs. Facility
Some operators deploy smaller battery banks close to the rack to catch the fastest transients. They pair these with a larger facility-scale BESS for peak shaving and bridge power. The two serve different timescales. So, they are rarely substitutes for each other.
Battery Chemistry for AI Data Center BESS
AI data center duty cycles involve frequent, partial charge-discharge events, not one clean cycle a day. Lithium iron phosphate, or LFP, tends to hold up well under that kind of irregular cycling. It also offers strong thermal stability. That matters for compliance with codes covered in Sunlith’s NFPA 855 guide for large-format stationary storage.
Key Takeaways on AI Data Center BESS
Point
Why It Matters
AI data centers strain the grid two ways
Total demand is high, but the bigger design problem is millisecond-scale power swings during GPU training
Interconnection queues now stretch 5–8 years
AI data center BESS and other behind-the-meter resources bridge the gap until full grid connection
BESS covers four distinct jobs
Power smoothing, bridge power, peak shaving, and grid services can stack on one battery asset
Sizing depends on the job
Smoothing needs fast response and modest duration; bridge power needs sustained duration and real capacity
LFP suits AI data center duty cycles
Frequent partial cycling and thermal stability requirements favor LFP over other lithium chemistries
Frequently Asked Questions About AI Data Center BESS
What Is AI Data Center BESS?
BESS stands for battery energy storage system. AI data center BESS refers to on-site or co-located batteries. These batteries smooth GPU power swings, bridge grid connection delays, and manage peak demand charges.
How Much Power Do AI Data Centers Actually Use?
Individual GPU racks now draw 50 to 100 kW. That is up from just 5 to 10 kW for older server racks. At the facility level, large training clusters can pull tens to hundreds of megawatts. Notably, swings of similar size can occur within milliseconds.
Can Batteries Really Respond Fast Enough for GPU Power Swings?
Yes, when purpose-built for it. Battery and inverter combinations designed for fast response can absorb and release power within milliseconds. That is exactly the timescale GPU training swings operate on.
How Long Does BESS Deployment Take?
A dedicated BESS deployment typically takes 6 to 18 months, from order to commissioning. That is far faster than the five-plus-year interconnection queues many large loads now face.
Is BESS a Permanent Fix or a Bridge to Something Else?
It can be both, depending on the role. For instance, peak-shaving and power-smoothing functions are usually permanent.
BESS oversizing — deliberately installing more nameplate energy capacity than your immediate load demands — is one of the most debated decisions in battery storage project design. Therefore, getting this decision right has direct consequences for project ROI, battery longevity, and contracted performance guarantees. Furthermore, as storage markets mature and the Section 48E Investment Tax Credit continues to reshape project economics, understanding when BESS oversizing helps and when it hurts has never been more important.
In this guide, we break down the real pros and cons of BESS oversizing across residential, commercial and industrial (C&I), and utility-scale applications. Additionally, we provide a practical sizing framework, a direct comparison with the augmentation alternative, and clear guidance on how much oversizing is appropriate for each use case. For background on key BESS performance metrics, see our BESS specifications guide.
Key Takeaway BESS oversizing reduces average depth of discharge, extends cycle life, and provides a degradation buffer — but it carries real costs in capex, idle capacity, and calendar aging risk. Consequently, the right answer depends entirely on your use case, load profile, battery chemistry, and project economics.
What Is BESS Oversizing? Definition and Key Drivers
BESS oversizing means installing more nameplate energy capacity (kWh) or power capacity (kW) than the system is expected to dispatch on a daily basis under normal operating conditions. In other words, it is the deliberate act of selecting a battery system larger than the immediate load or solar coupling requirement.
The Four Main Reasons Projects Choose BESS Oversizing
Project developers and system designers choose BESS oversizing for four primary reasons. First, it provides a built-in degradation buffer — batteries lose capacity over time, so installing extra kWh upfront ensures the system still meets its contractual output at end of life (EOL). Second, it reduces the average depth of discharge (DoD), which significantly reduces electrochemical stress and extends cycle life. Third, it future-proofs the system against load growth — a facility adding EV chargers or expanding solar may outgrow a precisely sized BESS within three to five years. Finally, the ITC captures a larger credit on the full installed capacity at commissioning rather than on augmented modules added later.
BESS Oversizing vs Augmentation: Two Different Strategies
It is important to separate two strategies that are frequently conflated: oversizing (installing more capacity upfront) and augmentation (adding capacity later). Both address the degradation problem, but they carry very different economic and technical profiles. Whereas oversizing locks in capex on Day 1, augmentation defers cost — but at the risk of losing ITC eligibility on the additional modules. We explore this comparison in detail in Section 5.
Pros of BESS Oversizing: 7 Technical and Financial Benefits
1. Extended Cycle Life Through Lower Depth of Discharge
The single most significant technical benefit of BESS oversizing is the reduction in average Depth of Discharge (DoD). Battery cycle life is acutely sensitive to DoD: a LiFePO4 (LFP) cell discharged to 80% DoD typically delivers 3,000–6,000 cycles to 80% capacity retention, whereas the same cell cycled at 40% DoD can exceed 10,000 cycles. Moreover, for NMC chemistry, the spread is even wider. Therefore, oversizing directly reduces the daily DoD, keeping cells in the shallow-cycle, high-longevity operating zone. As a result, the total useful life of the system increases substantially — without any hardware change.
A peer-reviewed sizing study published in MDPI Energies confirmed that an oversized BESS consistently operates at approximately 30% DoD, significantly reducing cycling degradation compared to a precisely sized system. See our BESS cycle life comparison guide for detailed 0.5C vs 1C cycling data across liquid-cooled LFP formats.
2. Built-In Degradation Buffer for End-of-Life Performance
All BESS contracts and revenue agreements are written against end-of-life capacity, not nameplate. Consequently, a project designed to deliver 1 MWh at year 10 must either oversize at commissioning to absorb predicted capacity loss, or augment mid-life. BESS oversizing solves this directly: the 15–20% extra capacity at year 0 becomes the system’s normal operating capacity at year 8–10, after degradation has run its course. In addition, oversizing also enables developers to lock in capital expenditures at project outset, mitigating future cost uncertainty. For a deeper understanding of capacity fade mechanics, see our Battery State of Health (SoH) estimation guide.
3. Improved Round-Trip Efficiency at Partial Loads
Battery inverters and Power Conversion Systems (PCS) operate most efficiently when working well below their rated power ceiling. Therefore, an oversized BESS means the power electronics run at partial load more often, reducing switching losses and thermal stress. Across LFP systems, round-trip efficiency (RTE) typically reaches 90–95% in well-managed partial-load conditions versus 85–88% when the system is pushed to rated limits daily. Furthermore, professional system sizing guidelines recommend oversizing by 5–20% specifically to compensate for RTE losses over the project’s lifetime. For a full breakdown of how RTE impacts your PCS selection, visit our BESS PCS functions and features guide.
4. Future-Proofing for Load Growth
Commercial and industrial facilities are rarely static. An EV fleet charging infrastructure build-out, a new production line, additional HVAC loads, or expanded solar capacity can all push a precisely sized BESS into insufficiency within a few years. As a result, BESS oversizing provides headroom to absorb load growth without a full system redesign or costly inverter upgrades. For residential customers, similarly, oversizing by 10–20% accounts for future appliance electrification — heat pumps, EV charging, induction cooking — that increase household energy consumption over time. This is especially relevant given that electricity rates have increased 32% over the past decade and the trend is expected to continue.
5. Greater Resilience During Extended Outages
An oversized BESS provides substantially longer backup durations during grid outages. For instance, where a precisely sized system may sustain critical loads for 4–6 hours, a 25% oversized system of the same power rating extends that window to 5–7.5 hours without additional hardware. Consequently, for hospitals, data centres, manufacturing facilities, and off-grid microgrids, this resilience buffer is a core design requirement rather than an optional feature. In addition, BESS oversizing enables higher solar self-consumption ratios, because the system can absorb more excess PV generation that would otherwise be curtailed — especially in DC-coupled configurations. Our cylindrical vs prismatic LFP cell guide covers how cell format selection interacts with resilience design.
6. Tax Credit Maximisation Under Section 48E
Under the Section 48E Clean Electricity Investment Tax Credit, the ITC applies to the full installed nameplate capacity at commissioning. Projects beginning construction before 2033 can qualify for a base credit of 6% rising to 30% — or up to 50% with domestic content and labour standards — on the entire installed system. Therefore, oversizing at commissioning rather than augmenting later allows developers to capture ITC on the additional capacity now, when the credit is at its most generous. As documented by Energy-Storage.News, Pivot Energy uses optimisation models specifically to find the ‘sweet spot’ where overbuilding by 15–20% captures the full ITC while also reducing DoD and slowing the degradation curve.
7. Higher Solar Self-Consumption and Clipping Capture
In solar-plus-storage configurations, an oversized BESS absorbs more excess PV generation that would otherwise be curtailed — particularly in DC-coupled systems where the battery captures inverter clipping losses. Projects with aggressively sized solar arrays consequently benefit most from an oversized storage buffer, enabling higher self-consumption ratios and better time-of-use (ToU) arbitrage revenue. Additionally, the flat voltage profile of LFP cells means the battery can accept charge across a wider SoC range without significant efficiency loss, making it well-suited to absorbing variable clipping events.
Cons of BESS Oversizing: 7 Real Drawbacks to Weigh
1. Higher Upfront Capital Expenditure
The most obvious downside of BESS oversizing is cost. At current commercial LFP BESS pricing of $220–$320 per kWh (nameplate, installed), adding 15–25% extra capacity translates directly into a 15–25% larger capital outlay. For example, on a 1 MWh C&I project, the oversizing premium reaches $33,000–$80,000. On a 10 MWh utility-scale project, the figure climbs to $330,000–$800,000. As a result, higher capex extends payback periods, dilutes IRR, and increases financing costs. Moreover, the 20/80 rule for battery SoC management — explored in our 20/80 rule for batteries guide — shows that moving from a 90% DoD strategy to a strict 60% DoD strategy for the same usable energy requires installing roughly 33% more nameplate capacity, at a steep capex premium.
2. Idle Capacity — Stranded Capital
An oversized BESS, by definition, contains capacity that is not used every day. In a system with a 30% oversizing factor, approximately 23% of the installed kWh is functionally stranded under normal operating conditions — generating no direct revenue, not contributing to peak shaving, and not offsetting grid draw. Therefore, for merchant revenue projects where every kWh of contracted discharge must justify its hardware cost, idle capacity directly weakens the financial case. Consequently, a detailed financial model comparing oversized vs precisely sized scenarios is essential before committing to an aggressive oversizing strategy.
3. Calendar Aging at High State of Charge
There is a subtle but real risk in BESS oversizing: a battery that is rarely deeply discharged will consequently spend more time at a high state of charge (SoC) between cycles. For LFP, this matters less due to the flat voltage curve, but for NMC and NCA chemistries, sustained high SoC accelerates calendar aging through lithium plating and electrolyte decomposition. The EMS must therefore be configured with SoC upper limits (typically a 90% ceiling) to mitigate this risk, which further reduces the usable window — partially negating the oversizing benefit.
4. Larger Physical Footprint and Permitting Complexity
A larger BESS means more rack space, additional container units, larger electrical rooms, and more complex fire suppression under NFPA 855 setback requirements. For urban C&I projects, rooftop installations, or sites with constrained footprints, BESS oversizing may simply not be feasible without additional civil and structural engineering. As a result, the incremental cost of accommodating a larger system can erode or eliminate the economic benefit of the additional capacity.
5. Risk of Over-Engineering Against Inaccurate Load Projections
BESS oversizing is typically justified by load growth projections that may not materialise. A facility forecasting 30% energy consumption growth over five years but actually growing 10% has paid a significant capex premium for capacity that will never be fully utilised. Furthermore, the further into the future the projections extend, the less reliable they become — and the weaker the economic case for aggressive oversizing. Therefore, right-sizing discipline, grounded in real interval load data, is essential before committing to an oversizing strategy.
6. Interconnection Limit Conflicts
Utility interconnection agreements define the maximum allowable power at the Point of Common Coupling (PCC). An oversized BESS that exceeds the permitted inverter or PCS rating — or that pushes a project over the interconnection ceiling — may require expensive distribution upgrades, transformer replacements, or grid impact studies. As a result, always validate that the oversized system’s power rating remains within interconnection constraints before finalising the design.
7. Diminishing Returns on ROI for Thin-Margin Projects
For projects where the economics are already marginal — low ToU spreads, limited demand charges, or thin merchant power prices — the additional capex of BESS oversizing may not be recoverable within the project’s financial life. Therefore, a right-sizing discipline, rather than aggressive oversizing, often produces better risk-adjusted returns on projects operating in challenging market conditions. Additionally, if battery prices continue to fall, augmentation at year 5–7 may deliver the same EOL capacity guarantee at a lower total lifecycle cost than oversizing today.
BESS Oversizing Pros and Cons: Quick-Reference Comparison Table
PROS of BESS Oversizing
CONS of BESS Oversizing
Extends cycle life by reducing average DoD
Higher upfront capital expenditure
Slower capacity degradation over project lifetime
Idle capacity — underutilised asset
Buffer for future load growth without re-powering
Larger footprint and space requirements
Improves round-trip efficiency at partial loads
Additional BMS / thermal management complexity
Strengthens resilience during extended outages
Risk of battery sitting at high SoC, accelerating calendar aging
Lock in ITC / 48E tax credits on full capacity now
Diminishing returns if load growth projections are wrong
Reduces depth of discharge and thermal stress
Potentially overshoots interconnection limits
Supports higher solar self-consumption
Makes ROI harder to justify on thin-margin projects
BESS Oversizing vs Augmentation: Which Degradation Strategy Wins?
The BESS oversizing debate is inseparable from its primary alternative: augmentation — the strategy of adding battery modules at year 5 or 7 to restore degraded capacity. However, these strategies are not equivalent, and the right choice depends on several project-specific factors.
Factor
BESS Oversizing (Upfront)
Augmentation (Mid-Life)
Capex Timing
Higher Day-1 cost; lower total lifecycle cost
Lower Day-1 cost; uncertain future capex at year 5–7
ITC Eligibility
Full credit on entire capacity at commissioning
Augmented capacity may miss ITC or face FEOC risk
Degradation Benefit
Reduces DoD and slows degradation from Day 1
Addresses degradation after it has occurred
Space Planning
Must install full footprint upfront
Must reserve physical and electrical space for future modules
Falling Battery Prices
Locks in today’s cost for future capacity
May benefit from lower prices at year 5
Complexity
Lower operational complexity
Requires mid-project procurement and system rebalancing
C&I with budget constraints; markets with falling storage prices
As battery prices continue to fall, augmentation is becoming more attractive for some project types. Nevertheless, as Pivot Energy’s modelling demonstrates, for ITC-sensitive projects, oversizing by 15–20% upfront typically produces better risk-adjusted NPV than augmentation — particularly given the difficulty of qualifying augmented capacity for the same ITC rate under the One Big Beautiful Bill Act.
How Much BESS Oversizing Is Right? A Use-Case Sizing Guide
There is no universal BESS oversizing percentage. Instead, the right buffer depends on your use case, battery chemistry, load profile, and project economics. However, the table below provides a practical reference framework covering the most common project types:
Use Case
Recommended BESS Oversizing
Rationale
Key Risk if Under-Sized
Residential Solar + Storage
10–20%
Compensate for DoD and RTE losses; buffer seasonal variation
Example: 30 kWh/day load × 2 autonomy days = 60 kWh base ÷ 0.85 DoD × 0.92 RTE = 76.6 kWh nameplate minimum + 15% degradation buffer = approximately 88 kWh recommended nameplate capacity
Note: For LFP chemistry with a 90% DoD operating window, adjust DoD factor accordingly.
For LFP chemistry specifically, the degradation benefit of BESS oversizing is more modest than for NMC or NCA, because LFP already exhibits a flatter voltage curve and superior cycle life at high DoD. Therefore, the most rigorous approach — as recommended in NREL’s Energy Storage Modelling guidelines and the IEA’s Batteries and Secure Energy Transitions report — is to use simulation tools such as NREL’s SAM or PVsyst with real 15-minute interval load data to determine the optimal capacity that minimises LCOE while meeting the contracted capacity guarantee at EOL.
Does Battery Chemistry Change the BESS Oversizing Calculus?
Yes — significantly. However, the extent to which BESS oversizing is beneficial varies considerably by chemistry. Here is how the most common BESS chemistries interact with oversizing strategy:
LFP (LiFePO4): The Most Common Choice for Commercial BESS
LFP already offers exceptional cycle life — 6,000–10,000+ cycles at 0.5C to 80% SoH — a flat voltage curve that reduces SoC-related aging, and thermal stability above 270°C. Therefore, the benefit of BESS oversizing for LFP is real but more modest than for NMC. A 10–15% oversizing factor is typically sufficient for residential and C&I LFP projects, unless extended autonomy is a primary requirement. For a detailed comparison of LFP cell formats, see our cylindrical vs prismatic LFP guide.
NMC (Nickel Manganese Cobalt): Greater Benefit from Oversizing
NMC cells are more sensitive to both high SoC and high DoD. The cycle life penalty for deep discharging is steeper, and calendar aging at high SoC is more pronounced. Consequently, for NMC-based systems, BESS oversizing by 20–30% can provide meaningful cycle life extension. However, the EMS must be configured to avoid sustained high-SoC parking, which otherwise accelerates precisely the degradation the oversizing was intended to prevent.
NCA (Nickel Cobalt Aluminium): Strongest Case for Oversizing
NCA is even more sensitive to DoD extremes than NMC. Therefore, BESS oversizing is strongly recommended for NCA systems, alongside strict SoC window management — typically a 20–90% operational band. As a result, NCA-based utility-scale systems frequently carry 20–30% oversizing factors as a standard design requirement.
When to Choose BESS Oversizing — and When to Avoid It
Oversize Your BESS When These Conditions Apply
Your project carries a 10+ year contract or PPA with capacity guarantee provisions that must be met at end of life
You are qualifying for ITC / Section 48E and want to maximise the tax credit on the full installed capacity at commissioning
The site has a clear load growth trajectory — EV charging, electrification roadmap, or solar expansion planned
You are designing an off-grid or critical backup system where autonomy days are non-negotiable
NMC or NCA chemistry is specified and DoD reduction delivers a significant cycle life benefit
Your DC-coupled solar array is oversized relative to the inverter and the battery can capture clipping energy
The incremental capex of BESS oversizing is recoverable within the project financial model
Avoid BESS Oversizing When These Conditions Apply
Project economics are already thin and additional capex pushes IRR below the acceptable threshold
Load forecasts are highly uncertain and growth projections lack solid 15-minute interval data support
Physical space constraints make a larger system impractical or disproportionately expensive to install
The interconnection agreement caps power capacity at a level that already constrains daily dispatch
Battery prices are falling rapidly in your market and augmentation in year 5–6 will be substantially cheaper
LFP chemistry is specified and daily DoD is already inherently low (below 60%) with proper sizing
The Four-Step BESS Oversizing Decision Framework
Rather than guessing at an oversizing percentage, use this structured four-step framework to determine whether BESS oversizing is appropriate for your project and, if so, by how much. As a result, you will arrive at a defensible, financially grounded nameplate capacity rather than an arbitrary rule of thumb.
Step 1 — Load Analysis: Gather Real Interval Data
First, collect at least 12–24 months of 15-minute interval load data. Identify peak demand events, average daily consumption, and seasonal variation patterns. This step is non-negotiable: BESS oversizing justified by rough annual consumption estimates rather than interval data almost always produces either over-engineered or under-performing systems.
Step 2 — Base Capacity Calculation
Next, apply the standard sizing formula — daily load × autonomy days ÷ (DoD × RTE) — to establish the minimum required nameplate capacity. This gives you the floor, not the target. However, it also reveals exactly how sensitive the result is to your DoD and RTE assumptions.
Step 3 — Apply Chemistry and Use-Case Correction
Subsequently, determine your oversizing factor based on battery chemistry (LFP vs NMC vs NCA), use case (peak shaving vs backup vs grid services), and EOL capacity requirement. Reference the sizing guide table in Section 6 for starting-point percentages, then adjust based on site-specific factors including climate, cycling frequency, and interconnection limits.
Step 4 — Financial Validation: Model Both Scenarios
Finally, model the oversized vs precisely sized scenarios in a full project NPV and IRR analysis, incorporating ITC capture, degradation trajectory, load growth assumptions, and augmentation cost projections. As a result, you will arrive at the scenario that maximises risk-adjusted return while meeting contracted performance obligations. Choose the strategy with the superior risk-adjusted NPV — not the one that simply installs the most battery.
Conclusion: BESS Oversizing Is a Strategy, Not a Default
BESS oversizing is one of the most powerful tools in a storage developer’s arsenal — but only when applied with precision. When the economics support it, oversizing by 10–25% delivers longer cycle life, a built-in degradation buffer, greater resilience, higher solar self-consumption, and maximised ITC capture. Conversely, when applied without a sound load analysis and financial model, it simply commits capital to cells that will never discharge.
The right approach is always project-specific. Therefore, an LFP C&I peak shaving project with a 10-year capacity guarantee may need 15–20% BESS oversizing to meet EOL targets. A residential grid-tied backup system with low daily DoD requirements may need only 10%. An off-grid microgrid with strict autonomy requirements and no grid fallback may need 25–30%. Furthermore, as battery prices continue to fall, the break-even point between oversizing and augmentation will shift — making it essential to rerun the financial model on each new project rather than applying a fixed rule.
At Sunlith Energy, every BESS project we design goes through a rigorous sizing and degradation modelling process — using real interval load data, validated chemistry models, and financial sensitivity analysis. To learn more about how we approach BESS design, explore our BESS specifications guide, our Battery SoH estimation guide, or review the NLR Grid-Scale Battery Storage Technology Basics for independent technical context. The goal is never the largest battery — it is the right battery, sized correctly for your project’s lifetime.
Ready to size your BESS correctly? Contact the Sunlith Energy team for a technical consultation. We combine 14+ years of LiFePO4 expertise with advanced degradation modelling to design storage systems that perform at end of life, not just on commissioning day.
Yes — peak shaving and load shifting can work at the same time. In fact, combining both is one of the most effective ways to cut commercial electricity costs.
However, many businesses use only one approach. As a result, they leave significant savings on the table every month.
In this guide, you will learn how each strategy works, why they complement each other, and how to run both together — with examples from India and global markets.
Can You Do Peak Shaving and Load Shifting at the Same Time?
The short answer is yes. These two strategies target different parts of your electricity bill. Because of this, they do not compete — they complement each other.
Peak shaving cuts your highest power demand in any 15-minute billing window.
Load shifting moves energy-heavy tasks to cheaper, off-peak hours.
Together, peak shaving and load shifting attack your bill from two sides at once. One flattens demand spikes. The other cuts energy costs during expensive periods.
Therefore, any business running both will always save more than one using just one strategy.
What Each Strategy Does on Its Own
Peak shaving cuts demand spikes. Load shifting moves usage to cheaper hours. Both reduce costs differently.
Before combining them, it helps to understand what each approach does separately.
What Is Peak Shaving?
Peak shaving cuts your highest power draw during the billing period. Most businesses use a Battery Energy Storage System (BESS) to do this.
Your BESS charges during low-demand periods. It then discharges during spikes. As a result, your utility records a lower peak — and your demand charge drops.
Load shifting reschedules energy-heavy tasks to times when electricity is cheaper. For example, you might run heavy machinery at night instead of during peak afternoon hours.
Moreover, in markets with Time of Use (TOU) tariffs — including many Indian states — this directly lowers your energy charge.
When you combine peak shaving and load shifting, each strategy makes the other more effective.
Load Shifting Reduces the Work Your BESS Has to Do
If you shift heavy loads to off-peak hours, you create fewer spikes during peak periods. That means your BESS has less work to do.
Your system can then be smaller — and cheaper. As a result, upfront investment drops and payback time improves.
Peak Shaving Covers the Spikes Load Shifting Cannot Plan For
Not every power spike is predictable. For example, emergency equipment, HVAC surges, or unplanned production runs can create sudden peaks.
This is where peak shaving steps in. Your BESS responds automatically — even when load shifting cannot plan ahead.
Together They Cut Both Parts of Your Bill
Load shifting lowers your energy charge — the cost per kWh consumed. Peak shaving lowers your demand charge — the cost based on your peak kW.
In contrast, using only one strategy leaves one part of your bill untouched. That means you are always leaving savings behind.
Combined Savings Example A manufacturing facility shifts startup loads to 6 AM (off-peak). This drops their afternoon peak from 800 kW to 600 kW. Their BESS then shaves that 600 kW peak down to 420 kW. Result: demand charge falls by 47% and energy charges drop by 18% — a combined saving of over Rs 3.2 lakh per month.
Using peak shaving and load shifting together produces far greater savings than either strategy alone.
Peak Shaving and Load Shifting in India
In fact, combining both strategies is especially powerful in India. This is because Indian tariffs penalise peak demand heavily — and TOU pricing is now common across most major states.
How TOU Tariffs Make Load Shifting More Valuable
Many Indian DISCOMs now apply Time of Day (ToD) tariffs. These charge higher rates during peak grid hours — typically 6 PM to 10 PM.
For example, in Maharashtra (MSEDCL), peak-hour energy rates can be 20–50% higher than off-peak rates. Therefore, shifting loads out of these hours directly cuts your energy bill.
How MD Charges Make Peak Shaving Essential
Indian DISCOMs charge Maximum Demand (MD) fees in Rs/kVA or Rs/kW per month. A single high-demand event sets your fee for the whole month.
Importantly, exceeding your contracted MD even once triggers a penalty of 1.5x to 2x the standard rate. As a result, BESS-based peak shaving protects against both the base MD charge and unexpected penalties.
The Recommended Approach for Indian Businesses
First, use load shifting to move planned loads out of ToD peak hours. This reduces your demand before it even registers on the meter.
Then, size your BESS to handle only the remaining unplanned spikes. This minimises both capital cost and your monthly bill at the same time.
India Strategy Tip Apply load shifting first — it is low-cost and takes effect in the very first billing cycle. Then right-size your BESS based on what peak demand remains. This order gives you the fastest payback and the lowest upfront investment.
How to Combine Peak Shaving and Load Shifting in Your Facility
Running both strategies does not have to be complex. Modern energy management systems (EMS) can automate them both at the same time.
Step 1 — Map Your Load Profile for Peak Shaving and Load Shifting
First, get a clear picture of when and how your facility uses electricity. Your utility meter data or an energy audit will show your daily load curve.
Look for two things: predictable high-load events and unpredictable spikes. This step tells you where to apply load shifting and how large a BESS you need.
Step 2 — Apply Load Shifting to Cut Planned Peaks
Move every predictable high-load task out of peak pricing windows. For example, pre-cool your facility before peak hours start, or reschedule batch production to night shifts.
Moreover, this step costs very little to implement. It also reduces the size — and cost — of the BESS you will need in the next step.
Step 3 — Install a BESS to Handle Remaining Demand Spikes
After load shifting, review what peak demand remains. Size your BESS to shave those remaining spikes down to your target peak level.
A well-designed system handles both planned and unplanned spikes automatically. As a result, you get consistent savings every month — with no manual work required.
Step
Action
Targets
Typical Saving
1 — Load audit
Map your full load profile
Understanding baseline
—
2 — Load shifting
Move predictable loads to off-peak
Energy charge + smaller peaks
10–20% on energy charge
3 — BESS install
Shave remaining demand spikes
Demand / MD charge
20–40% on demand charge
Combined result
Both strategies running together
Full bill optimisation
25–50% total bill saving
FAQ — Peak Shaving and Load Shifting
Q: Do peak shaving and load shifting work for all business sizes?
A: Yes. Load shifting suits almost any business with flexible operations. Peak shaving with BESS is most cost-effective above 100 kW demand, but smaller systems are now available for mid-sized businesses too.
Q: Can I use solar to support both peak shaving and load shifting?
A: Yes. Solar charges your BESS during the day. Your BESS then discharges during evening demand peaks — supporting peak shaving. At the same time, solar reduces daytime energy consumption, which complements load shifting.
Q: Is a BESS required to combine both strategies?
A: Load shifting does not need a BESS — it is a scheduling strategy. However, peak shaving requires a BESS to be effective. Combining both gives you the greatest savings and the most flexibility.
Q: How do Indian DISCOM tariffs affect the combined strategy?
A: Indian ToD tariffs make load shifting highly valuable. Moving loads out of peak hours (6–10 PM) saves 20–50% on energy charges in many states. BESS peak shaving then handles MD charges and unplanned spikes — covering both main cost components of an Indian electricity bill.
Q: How quickly will I see savings from combining both strategies?
A: Load shifting savings appear in your very first billing cycle — within 30 days. BESS payback takes 4–6 years, but monthly savings begin immediately after installation.
Sources and Further Reading
The data and benchmarks in this article are drawn from:
Peak shaving and load shifting are not competing strategies. So using both at the same time always delivers better results than using just one.
However, the order matters. Start with load shifting — it is low-cost and cuts peaks right away. Then use a BESS to handle what remains.
Together, these strategies can cut your total electricity bill by 25–50%. For Indian businesses, the combination is especially powerful — ToD tariffs reward load shifting, and MD charges make peak shaving essential.
Sunlith Energy designs BESS systems that support both peak shaving and load shifting for maximum savings.
Want to Run Both Strategies in Your Facility? Sunlith Energy designs integrated C&I energy systems that combine BESS peak shaving and load shifting — built for Indian commercial and industrial businesses. Get a free energy assessment and find out how much your facility could save.
In the world of commercial and industrial battery energy storage systems (C&I BESS), performance and reliability depend on more than just advanced batteries and control systems. One often overlooked component is the BESS enclosure. Enclosures act as the first line of defense against dust, moisture, temperature extremes, and physical damage. The use of IP-rated C&I BESS enclosures ensures not only long-term performance but also compliance with global safety standards.
At Sunlith Energy, we design enclosures that balance safety, efficiency, and scalability for diverse applications in renewable energy, EV charging hubs, and grid support.
What Are IP Ratings in C&I BESS Enclosures?
An IP ratinghttps://www.iec.ch/ip-ratings (Ingress Protection) defines how well an enclosure resists dust and water penetration. For C&I BESS enclosures, this rating is crucial because systems are often deployed in harsh industrial or outdoor environments.
IP54: Basic indoor protection against dust and splashing water.
IP65: Outdoor-level dust-tight enclosure with water spray protection.
IP67: Resistant to immersion, suitable for flood-prone areas.
IP69K: Extreme protection against high-pressure water jets and severe environments.
Unlike residential systems, C&I energy storage systems face more demanding operational conditions. Choosing the right C&I BESS enclosure enhances:
Durability – Prevents dust buildup that can impair cooling systems and electronics.
Safety – Reduces the risk of short circuits and fire hazards caused by moisture ingress.
Performance – Maintains thermal stability and system efficiency under varying climates.
Compliance – Supports certifications for safe operation in industrial and utility environments.
Indoor vs Outdoor Applications
Different C&I projects demand different enclosure strategies:
Indoor C&I BESS enclosures (IP54–IP65): Suitable for factories, warehouses, and commercial spaces. They provide moderate dust and moisture protection while maintaining cost efficiency.
Outdoor C&I BESS enclosures (IP65–IP67): Essential for solar farms, EV fast-charging stations, and microgrids where systems face rain, dust storms, and high humidity.
This careful selection ensures maximum uptime and reduced maintenance costs.
C&I BESS Enclosures and Safety Standards
IP ratings directly contribute to safety and compliance by ensuring protection from hazards such as:
Electrical shocks due to water intrusion
Overheating caused by blocked airflow
Contamination from dust and industrial particles
At Sunlith Energy, we integrate IP-rated enclosures as part of a broader compliance strategy that aligns with UL, IEC, and fire safety standards.
When selecting an enclosure for your C&I battery storage project, consider:
Environment: Dusty factories, coastal areas, or flood-prone zones need higher IP ratings.
Application: Indoor projects may optimize for cost with IP54, while outdoor utility-scale projects require IP65–IP67.
Scalability: Larger systems benefit from modular enclosures with high IP protection to ensure reliability as capacity grows.
Conclusion: Enclosures Define Reliability
C&I BESS enclosures are not just boxes that house batteries; they are a critical safeguard that ensures performance, reliability, and compliance. By choosing the right IP-rated enclosure, businesses protect their investments, enhance safety, and enable long-term sustainability in energy storage projects.
At Sunlith Energy, we provide advanced C&I BESS solutions with enclosures tailored to industrial and commercial needs, ensuring that your system is built to last.
Frequently Asked Questions (FAQ) about C&I BESS Enclosures
1. What is an IP-rated C&I BESS enclosure?
An IP-rated C&I BESS enclosure is a protective housing designed for commercial and industrial battery energy storage systems. The IP rating specifies how well the enclosure resists dust and water, ensuring safety and durability in challenging environments.
2. Why are IP ratings important for C&I BESS?
IP ratings define how resistant enclosures are to dust and water intrusion. For C&I BESS enclosures, higher IP ratings mean better protection, which translates into improved system reliability, longer lifespan, and compliance with industry safety standards.
3. Which IP rating is best for C&I BESS enclosures?
The choice depends on the application:
IP69K: Used in extreme industrial conditions where systems face high-pressure cleaning or severe weather.
IP54–IP65: Best for indoor commercial or industrial settings.
IP65–IP67: Ideal for outdoor environments exposed to rain, dust, and humidity.
4. How do C&I BESS enclosures improve safety?
By preventing water, dust, and debris from entering the system, C&I BESS enclosures reduce the risk of electrical faults, overheating, and fire hazards. They also help ensure compliance with UL and IEC safety standards.
5. Do all commercial and industrial BESS require high-IP enclosures?
Not always. Indoor C&I BESS may only need moderate protection (e.g., IP54), while outdoor and utility-scale BESS demand higher protection (e.g., IP67). The correct choice balances cost, environment, and safety needs.
6. How does Sunlith Energy ensure quality in its C&I BESS enclosures?
At Sunlith Energy, our enclosures are engineered with high-quality sealing, robust materials, and compliance with international standards. Each C&I BESS enclosure is tested for dust and water resistance to guarantee long-term reliability.
